State of Florida |
Public Service Commission Capital Circle Office Center ● 2540 Shumard
Oak Boulevard -M-E-M-O-R-A-N-D-U-M- |
||
DATE: |
|||
TO: |
Office of Commission Clerk (Stauffer) |
||
FROM: |
Division of Engineering (Wooten, Ellis, Wright) Division of Economics (Higgins) Office of the General Counsel (Dziechciarz) |
||
RE: |
|||
AGENDA: |
06/05/18 – Regular Agenda – Proposed Agency Action – Interested Persons May Participate |
||
COMMISSIONERS ASSIGNED: |
|||
PREHEARING OFFICER: |
|||
SPECIAL INSTRUCTIONS: |
Staff recommends the Commission simultaneously consider Docket Nos. 20180073-EQ, 20180081-EQ, 20180082-EQ, 20180083-EQ and 20180091-EQ |
||
Section 366.91(3), Florida Statutes (F.S.), requires that each investor-owned utility (IOU) continuously offer to purchase capacity and energy from renewable energy generators and small qualifying facilities. Florida Public Service Commission (Commission) Rules 25-17.200 through 25-17.310, Florida Administrative Code (F.A.C.), implement the statute and require each IOU to file with the Commission by April 1 of each year, a standard offer contract based on the next avoidable fossil fueled generating unit of each technology type identified in the Utility’s current Ten-Year Site Plan. On April 2, 2018, Florida Power & Light Company (FPL) filed a petition for approval of its revised standard offer contract and renewable energy tariff based on its 2018 Ten-Year Site Plan[1]. On April 20, 2018, FPL filed an amended petition for approval of the revised standard offer contract and revised accompanying rate schedule QS-2. Revisions made to the tariff sheets are consistent with the updated avoided unit and an avoided unit selection option. Revisions include updates to dates and payment information which reflect the current economic and financial assumptions for the avoided unit and purchased power costs.
The Commission has jurisdiction over this standard offer contract pursuant to Sections 366.04 through 366.06 and 366.91, F.S.
Issue 1:
Should the Commission approve the amended renewable energy tariff and standard offer contract filed by Florida Power & Light Company?
Recommendation:
Yes. The provisions of FPL’s revised renewable energy tariff and standard offer contract conform to the requirements of Rules 25-17.200 through 25-17.310, F.A.C. FPL’s 2018 Ten-Year Site Plan does not include any avoidable fossil fueled generating units, but has a projected planned purchase of 325 megawatt (MW) in 2019 that is FPL’s next planned purchase that could be avoided or deferred. FPL has also identified its next avoidable unit which is a 1,778 MW natural gas-fired combined cycle unit at a greenfield site with an expected in-service date of June 1, 2028. FPL’s revised standard offer contract provides flexibility in the arrangement for payments so that a developer of renewable generation may select the payment stream best suited to its financial needs. Staff recommends that FPL’s revised renewable energy tariff and standard offer contract be approved as filed. (Wooten, Wright, Higgins)
Staff Analysis:
Rule 25-17.250, F.A.C., requires that FPL, an IOU, continuously make available a standard offer contract for the purchase of firm capacity and energy from renewable generating facilities (RF) and small qualifying facilities (QF) with design capacities of 100 kilowatts (kW) or less. Pursuant to Rules 25-17.250(1) and (3), F.A.C., the standard offer contract must provide a term of at least 10-years, and the payment terms must be based on the Utility’s next avoidable fossil-fueled generating unit identified in its most recent Ten-Year Site Plan or, if no avoided unit is identified, its next avoidable planned purchase. FPL’s 2018 Ten-Year Site Plan does not include any avoidable fossil fueled generating units but has a projected planned purchase of 325 MW in 2019 that would be FPL’s next planned purchase that could be avoided or deferred. However, in an effort to encourage renewable generation, FPL has identified its next avoidable unit as a 1,778 MW natural gas-fired combined cycle unit at a greenfield site with an expected in-service date of June 1, 2028. Both the avoided unit and avoided planned purchase options are available for FPL’s revised standard offer contract.
Under FPL’s standard offer contract, the RF/QF operator commits to certain minimum performance requirements based on the identified avoided unit, such as being operational and delivering an agreed upon amount of capacity by the in-service date of the avoided unit, and thereby becomes eligible for capacity payments in addition to payments received for energy. The standard offer contract may also serve as a starting point for negotiation of contract terms by providing payment information to an RF/QF operator, in a situation where one or both parties desire particular contract terms other than those established in the standard offer.

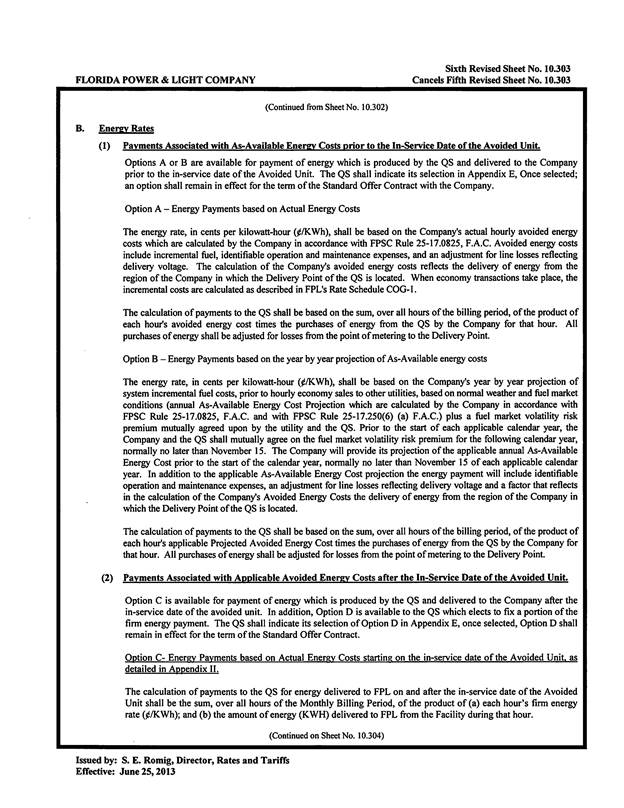

In order to promote renewable generation, the Commission requires the IOU to offer multiple options for capacity payments, including the options to receive early or levelized payments. If the RF/QF operator elects to receive capacity payments under the normal or levelized contract options, it will receive as-available energy payments only until the in-service date of the avoided unit (in this case June 1, 2028), and thereafter begin receiving capacity payments in addition to energy payments. If either the early or levelized option is selected, then the operator will begin receiving capacity payments earlier than the in-service date of the avoided unit. However, payments made under the early capacity payment options tend to be lower in the later years of the contract term because the net present value (NPV) of the total payments must remain equal for all contract payment options.
Table 1 below, contains estimates of the annual payments for each payment option available under the revised standard offer contract to an operator choosing the 2028 avoided unit option. This is available to an operator with a 50 MW facility operating at a capacity factor of 94 percent that meets the minimum requirement specified in the contract to qualify for full capacity payments. Normal and levelized capacity payments begin in 2028, reflecting the projected in-service date of the avoided unit (June 1, 2028).
Table 1 - Estimated Annual Payments to a 50 MW Renewable Facility
94 Percent Capacity Factor
Year |
Energy Payment |
Capacity Payment (By Type) |
|||
Normal |
Levelized |
Early |
Early Levelized |
||
$(000) |
$(000) |
$(000) |
$(000) |
$(000) |
|
2019 |
10,808 |
- |
- |
- |
- |
2020 |
9,513 |
- |
- |
- |
- |
2021 |
7,836 |
- |
- |
- |
- |
2022 |
8,501 |
- |
- |
- |
- |
2023 |
9,237 |
- |
- |
- |
- |
2024 |
9,730 |
- |
- |
2,445 |
2,825 |
2025 |
10,236 |
- |
- |
2,506 |
2,825 |
2026 |
11,235 |
- |
- |
2,569 |
2,825 |
2027 |
13,098 |
- |
- |
2,633 |
2,825 |
2028 |
12,312 |
4,111 |
4,581 |
2,699 |
2,825 |
2029 |
12,446 |
4,214 |
4,581 |
2,766 |
2,825 |
2030 |
12,992 |
4,319 |
4,581 |
2,835 |
2,825 |
2031 |
13,453 |
4,427 |
4,581 |
2,906 |
2,825 |
2032 |
13,930 |
4,538 |
4,581 |
2,978 |
2,825 |
2033 |
14,132 |
4,652 |
4,581 |
3,053 |
2,825 |
2034 |
14,483 |
4,768 |
4,581 |
3,129 |
2,825 |
2035 |
14,806 |
4,887 |
4,581 |
3,208 |
2,825 |
2036 |
15,178 |
5,009 |
4,581 |
3,288 |
2,825 |
2037 |
15,475 |
5,134 |
4,581 |
3,370 |
2,825 |
2038 |
15,820 |
5,263 |
4,581 |
3,454 |
2,825 |
Total |
256,132 |
51,323 |
50,391 |
43,839 |
42,373 |
NPV (2019$) |
115,228 |
15,671 |
15,671 |
15,671 |
15,671 |

Source: FPL’s Supplemental Response to Staff’s First Data Request.[2]
Table 2 below, contains estimates of the annual payments for each payment option available under the revised standard offer contract if an operator chooses the avoided planned power purchase contract. This contract is available to an operator with a 50 MW facility operating at a capacity factor of 94 percent that meets the minimum requirement specified in the contract to qualify for full capacity payments. Normal and levelized capacity payments begin in 2019, reflecting the projected purchase date of the avoided purchase (June 1, 2019).
Table 2 - Estimated Annual Payments to a 50 MW Renewable Facility
94 Percent Capacity Factor
Year |
Energy Payment |
Capacity Payment (By Type) |
|||
Normal |
Levelized |
Early |
Early Levelized |
||
$(000) |
$(000) |
$(000) |
$(000) |
$(000) |
|
2019 |
10,808 |
1,200 |
111.4 |
585.0 |
101.3 |
2020 |
9,513 |
- |
111.4 |
- |
101.3 |
2021 |
7,836 |
- |
111.4 |
- |
101.3 |
2022 |
8,501 |
- |
111.4 |
- |
101.3 |
2023 |
9,237 |
- |
111.4 |
- |
101.3 |
2024 |
9,730 |
- |
111.4 |
- |
101.3 |
2025 |
10,236 |
- |
111.4 |
- |
101.3 |
2026 |
11,235 |
- |
111.4 |
- |
101.3 |
2027 |
13,097 |
- |
111.4 |
- |
101.3 |
2028 |
12,948 |
- |
111.4 |
- |
101.3 |
2029 |
12,831 |
- |
111.4 |
- |
101.3 |
2030 |
13,175 |
- |
111.4 |
- |
101.3 |
2031 |
16,168 |
- |
111.4 |
- |
101.3 |
2032 |
14,297 |
- |
111.4 |
- |
101.3 |
2033 |
14,224 |
- |
111.4 |
- |
101.3 |
2034 |
15,670 |
- |
111.4 |
- |
101.3 |
2035 |
15,904 |
- |
111.4 |
- |
101.3 |
2036 |
15,985 |
- |
111.4 |
- |
101.3 |
2037 |
16,901 |
- |
111.4 |
- |
101.3 |
2038 |
17,123 |
- |
111.4 |
- |
101.3 |
Total |
266,330 |
1,200 |
2,228 |
585.0 |
2,025 |
NPV (2019$) |
118,240 |
1,033 |
1,033 |
1,033 |
1,033 |
Source: FPL’s Supplemental Response to Staff’s First Data Request.[3]

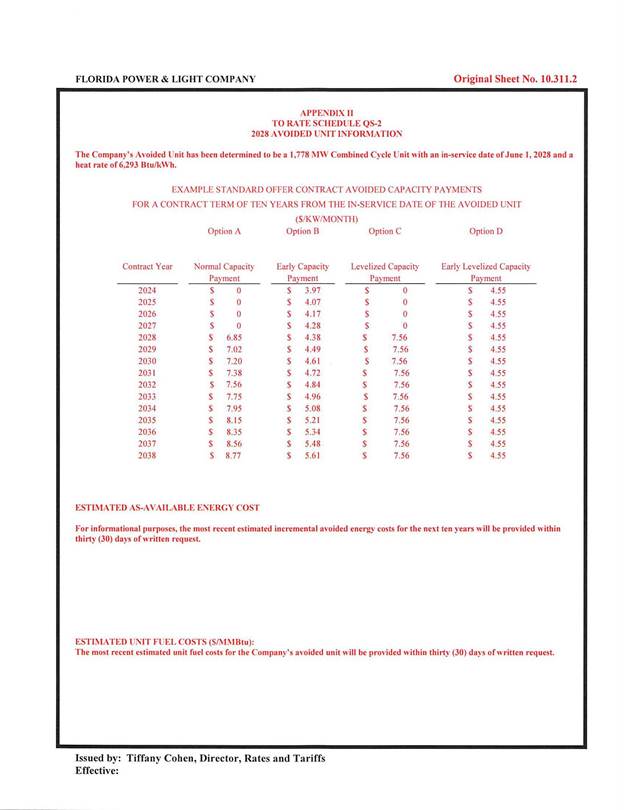

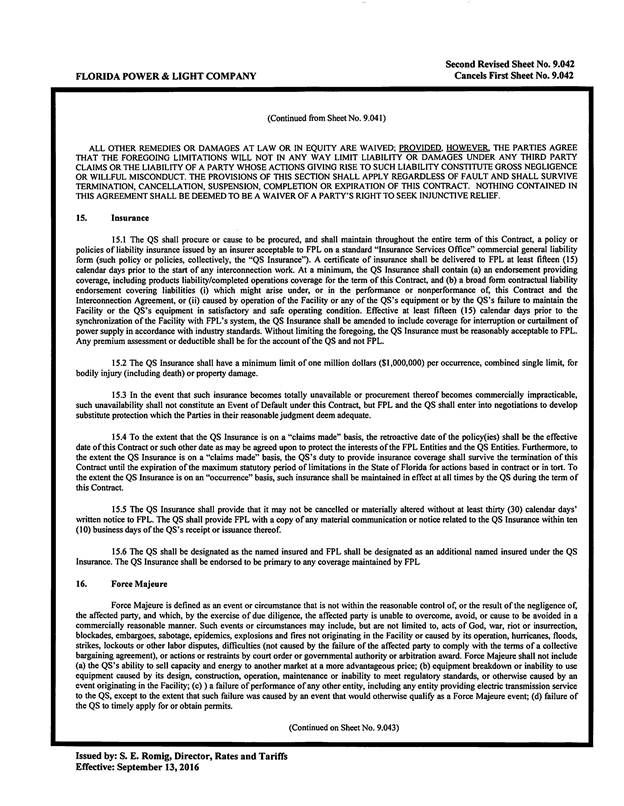

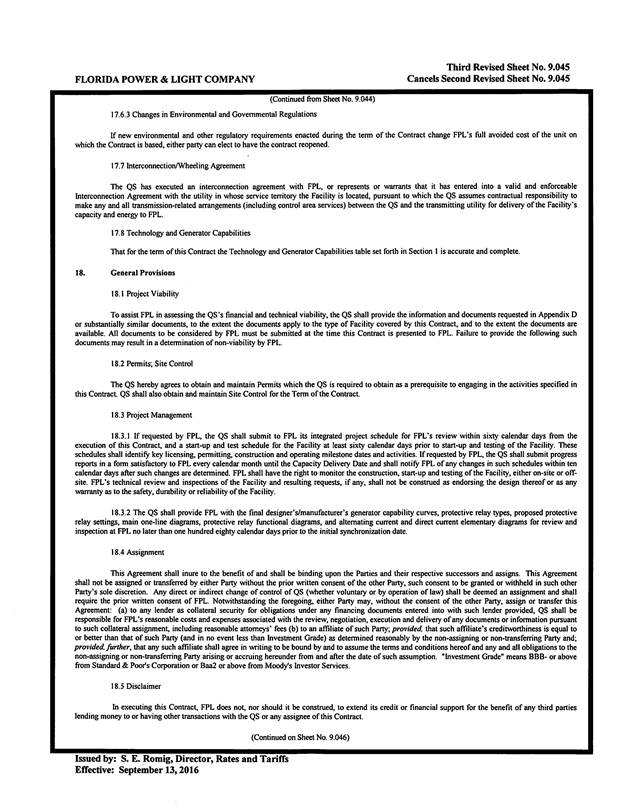

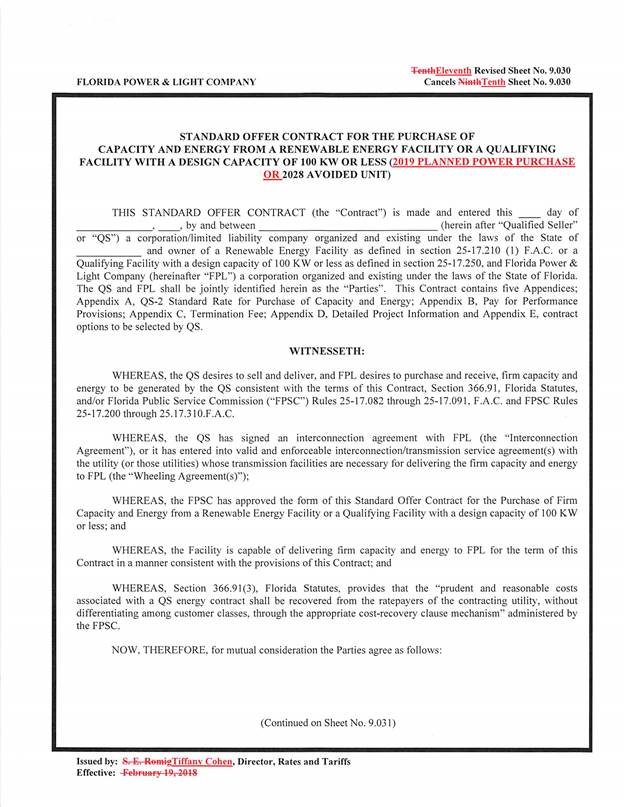

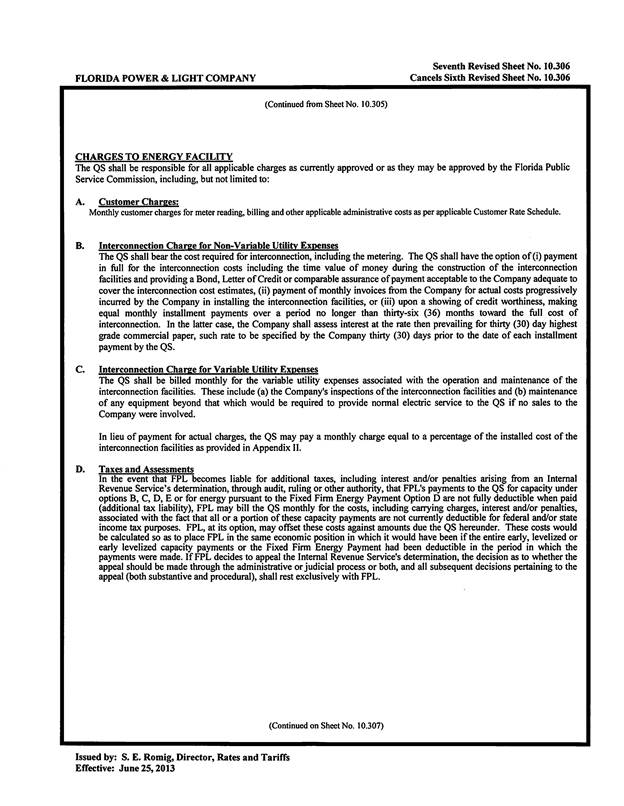

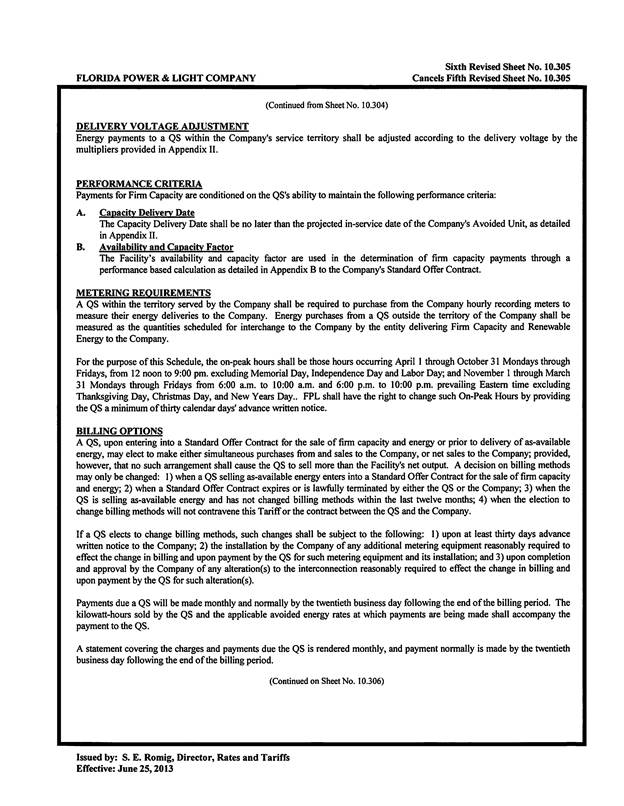

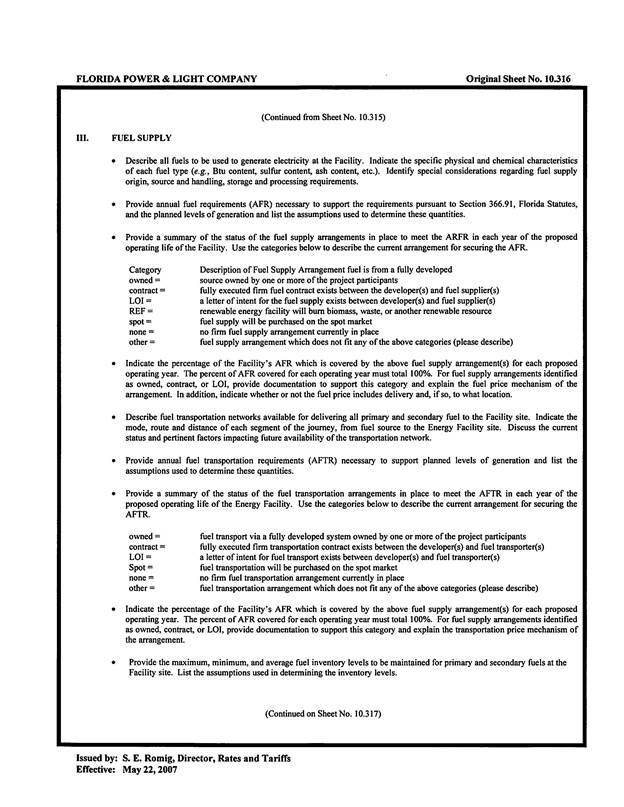

FPL’s revised renewable energy tariff and standard offer
contract, in type-and-strike format, are included as Attachment A to this
recommendation. All of the changes made to the tariff sheets are

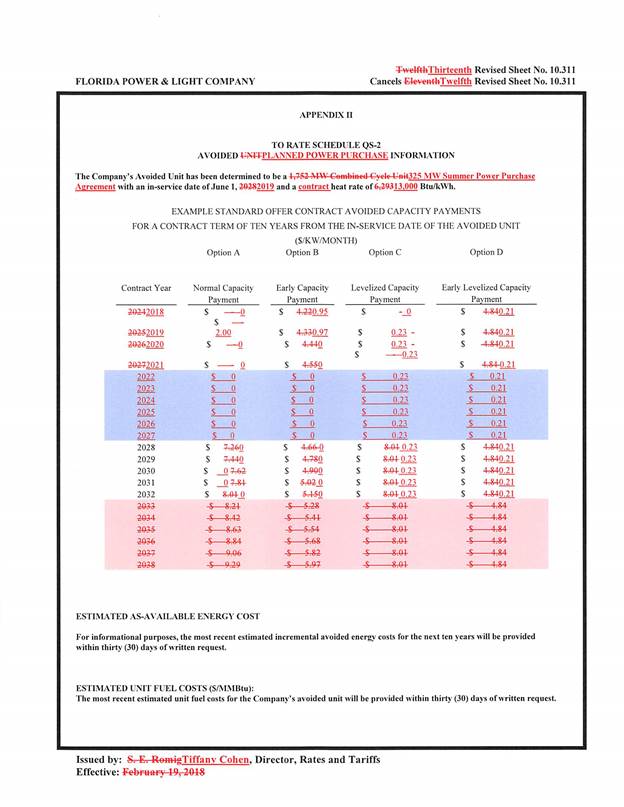

consistent with the updated avoided unit and an avoided unit selection option. Revisions
include updates to dates and payment information which reflect the current
economic and financial assumptions for the avoided unit and purchased power costs.
Additional language was introduced in Revised

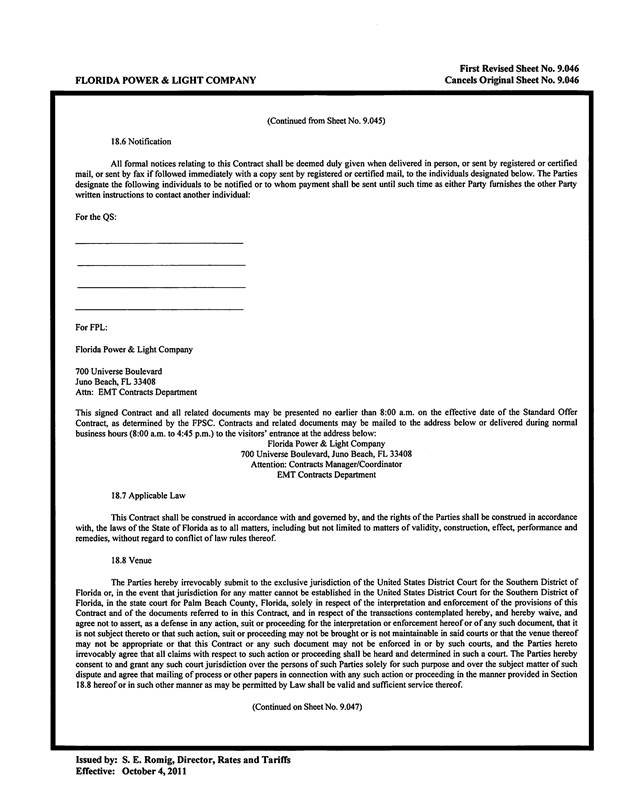

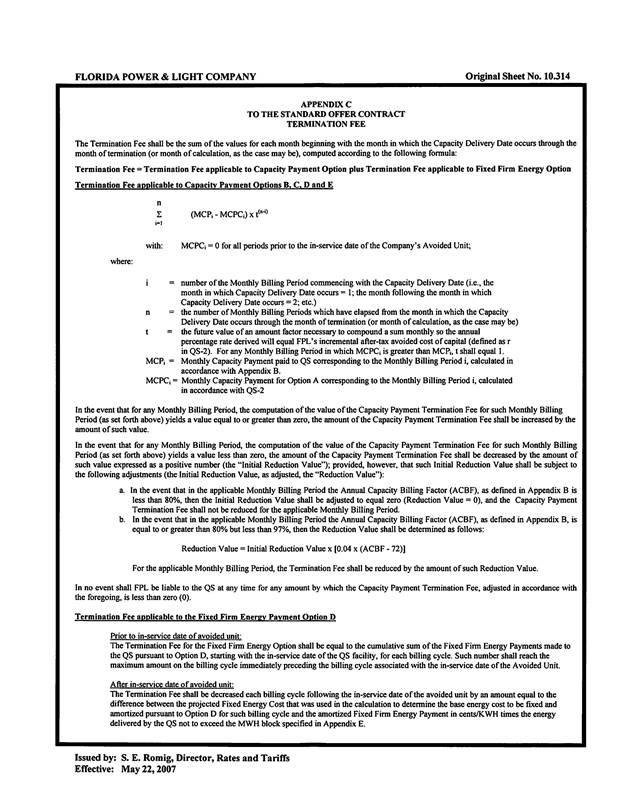

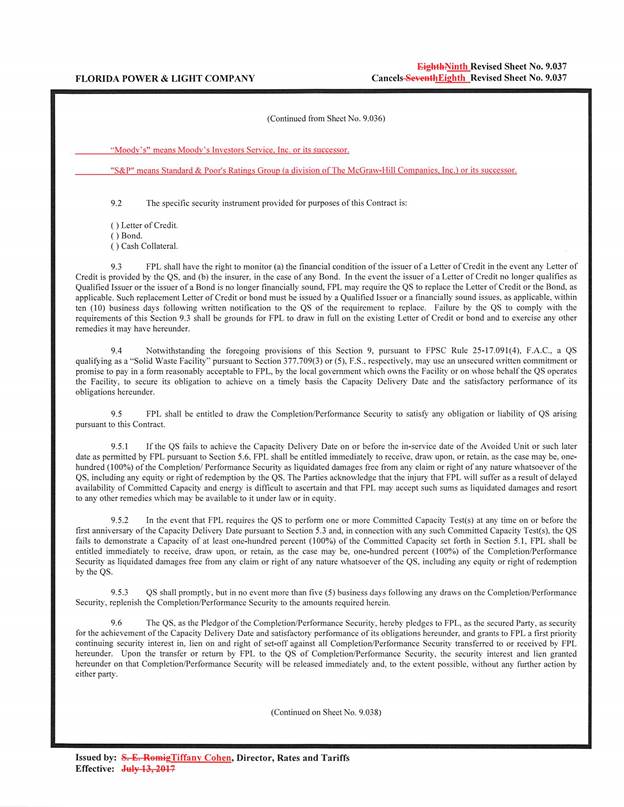

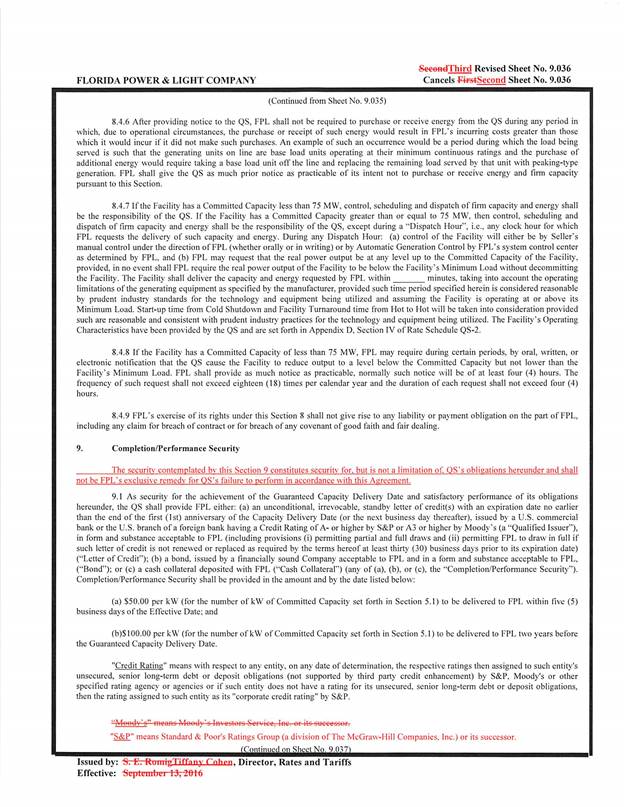

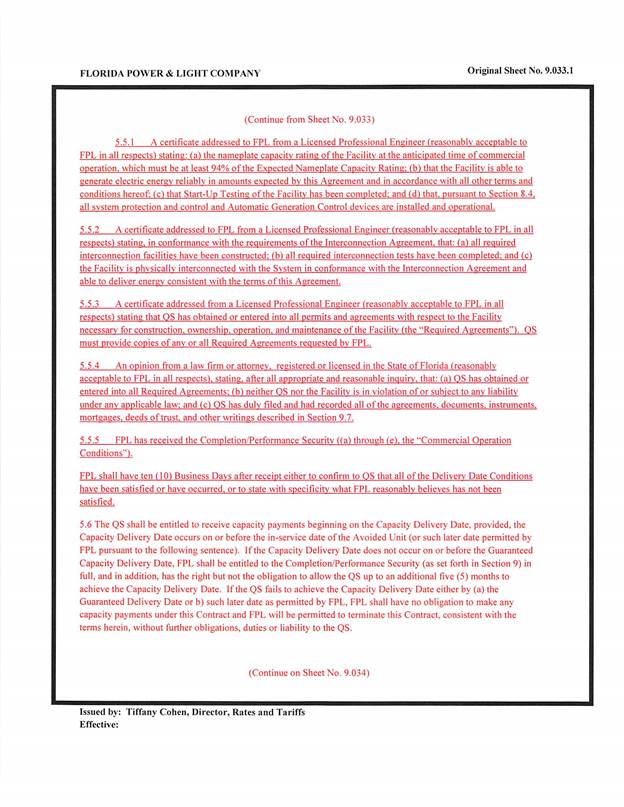

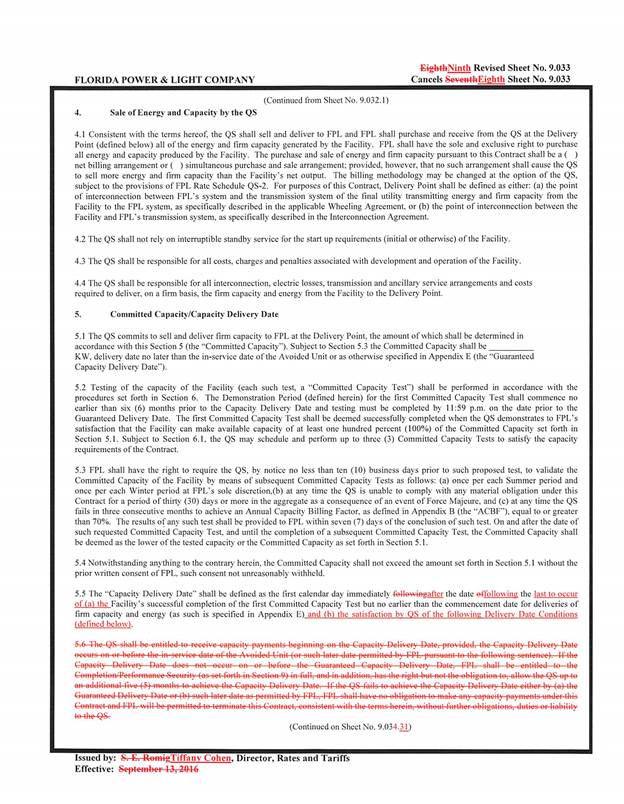

Sheet 9.033 and Original Sheet 9.033.1 that addressed “Capacity Delivery Date”

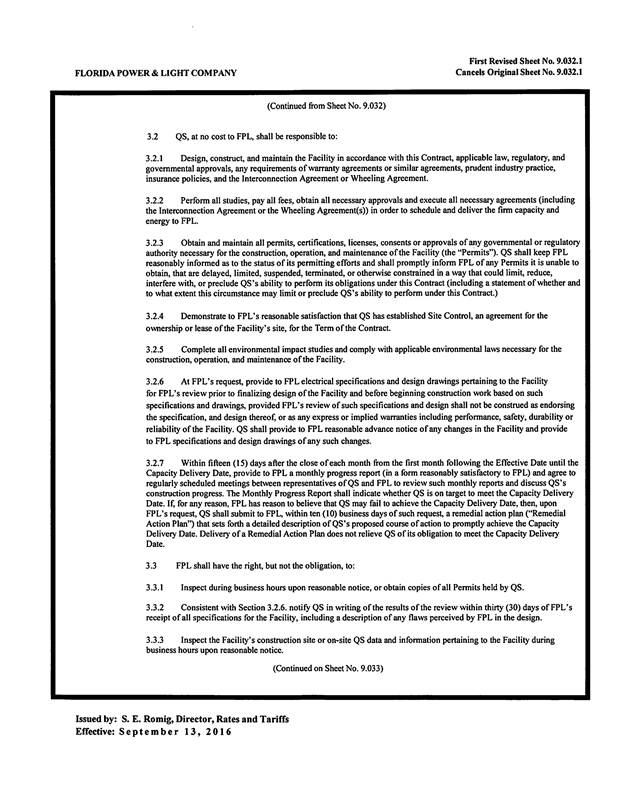

and “Delivery Date Conditions” that must be satisfied by the QF. In response to
a staff data request, FPL explained the clarifying language is significant and
essential for FPL because the Capacity Delivery Date is the date when the QF is
required to deliver to FPL, and is also the date when FPL is required to
receive and pay the Committed Capacity amount. FPL further clarified that the
additional Delivery Date Conditions are consistent with sound commercial practice
and will ensure that the QF will generate and deliver to FPL electric energy
safely and reliably for the Term of the Standard Offer Contract.
Conclusion
The provisions of FPL’s revised renewable energy tariff and standard offer contract conform to the requirements of Rules 25-17.200 through 25-17.310, F.A.C. FPL’s 2018 Ten-Year Site Plan does not include any avoidable fossil fueled generating units, but has a projected planned purchase of 325 megawatt (MW) in 2019 that is FPL’s next planned purchase that could be avoided or deferred. FPL has also identified its next avoidable unit as a 1,778 MW natural gas-fired combined cycle unit at a greenfield site with an expected in-service date of June 1, 2028. FPL’s revised standard offer contract provides flexibility in the arrangement for payments so that a developer of renewable generation may select the payment stream best suited to its financial needs. Staff recommends that FPL’s revised renewable energy tariff and standard offer contract be approved as filed.
Issue 2:
Should this docket be closed?
Recommendation:
Yes. This docket should be closed upon issuance of a consummating order, unless a person whose substantial interests are affected by the Commission’s decision files a protest within 21 days of the issuance of the Commission’s Proposed Agency Action Order. Potential signatories should be aware that, if a timely protest is filed, FPL’s standard offer contract may subsequently be revised. (Dziechciarz)
Staff Analysis:
This docket should be closed upon the issuance of a consummating order, unless a person whose substantial interests are affected by the Commission’s decision files a protest within 21 days of the issuance of the Commission’s Proposed Agency Action Order. Potential signatories should be aware that, if a timely protest is filed, FPL’s standard offer contract may subsequently be revised.
