State of Florida

pscSEAL

Public Service Commission

Capital Circle Office Center ● 2540 Shumard Oak Boulevard
Tallahassee, Florida 32399-0850

-M-E-M-O-R-A-N-D-U-M-

DATE:

May 28, 2020

TO:

Office of Commission Clerk (Teitzman)

FROM:

Division of Engineering (Kistner, Ellis)

Office of the General Counsel (Passidomo)

RE:

Docket No. 20200112-EQ – Petition for approval of revisions to standard offer contract and rate schedule COG-2, by Tampa Electric Company.

AGENDA:

06/09/20Regular Agenda – Interested Persons May Participate

COMMISSIONERS ASSIGNED:

All Commissioners

PREHEARING OFFICER:

Administrative

CRITICAL DATES:

None

SPECIAL INSTRUCTIONS:

None

 Case Background

Section 366.91(3), Florida Statutes (F.S.), requires each investor-owned utility (IOU) to continuously offer to purchase capacity and energy from renewable generating facilities and small qualifying facilities. Florida Public Service Commission (Commission) Rules 25-17.200 through 25-17.310, Florida Administrative Code (F.A.C.), implement the statute and require each IOU to file with the Commission, by April 1 of each year, a revised standard offer contract based on the next avoidable fossil fueled generating unit of each technology type identified in the utility’s current Ten-Year Site Plan. On April l, 2020, Tampa Electric Company (TECO) filed a petition for approval of its amended standard offer contract based on its 2020 Ten-Year Site Plan. The Commission has jurisdiction over this standard offer contract pursuant to Sections 366.04 through 366.055, and 366.91, F.S.

Discussion of Issues

Issue 1:

 Should the Commission approve the amended standard offer contract and rate schedule COG-2 filed by Tampa Electric Company?

Recommendation:

 Yes. The provisions of TECO’s amended standard offer contract and associated rate schedule COG-2 conform to all requirements of Rules 25-17.200 through 25-17.310, F.A.C. The amended standard offer contract provides flexibility in the arrangements for payments so that a developer of renewable generation may select the payment stream best suited to its financial needs. (Kistner)

Staff Analysis:

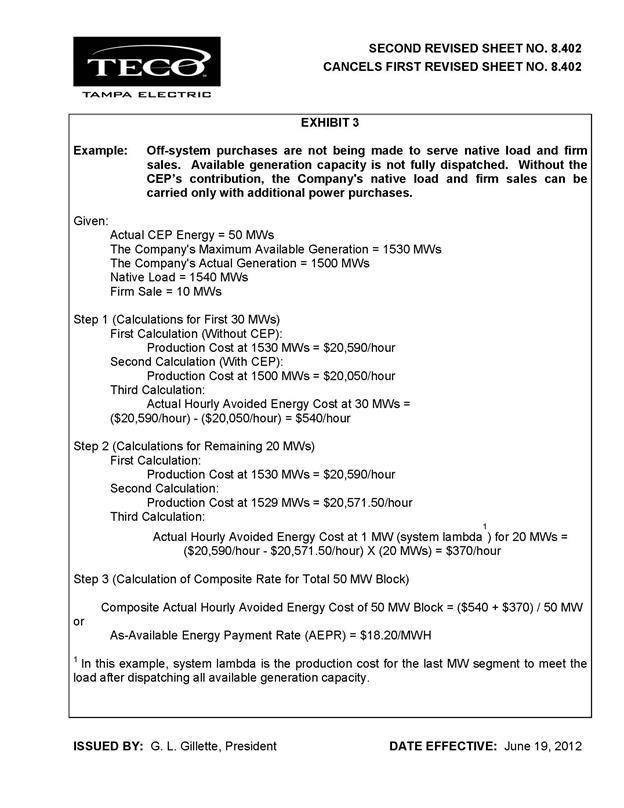

 Section 366.91(3), F.S., and Rule 25-17.250, F.A.C., require that TECO, an IOU, continuously make available a standard offer contract for the purchase of firm capacity and energy from renewable generating facilities (RF) and small qualifying facilities (QF) with design capacities of 100 kilowatts (kW) or less. Pursuant to Rules 25-17.250(1) and (3), F.A.C., the standard offer contract must provide a term of at least 10 years, and the payment terms must be based on the utility’s next avoidable fossil-fueled generating unit identified in its most recent Ten-Year Site Plan, or if no avoided unit is identified, its next avoidable planned purchase.

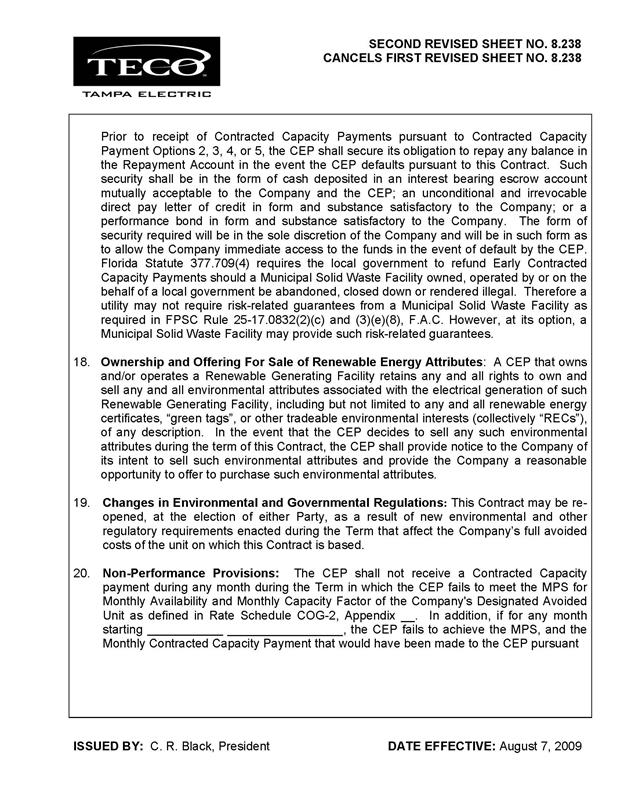

TECO has identified a 18.5 megawatt (MW) natural gas-fueled internal combustion reciprocating engine (IC) as the next avoidable planned generating unit in its 2020 Ten-Year Site Plan. TECO states that it selected the ICs over either combustion turbines or combined cycles to better match the size of its 2021 reserve margin need, and that ICs offered reliability benefits over other unit types. While there are no preset subscription limits under Rule 25-17.260, F.A.C., and an RF/QF may contract for more than the amount of the avoided unit, TECO must petition the Commission if it receives a standard offer contract that is not needed for reliability or would increase costs to the general body of ratepayers.

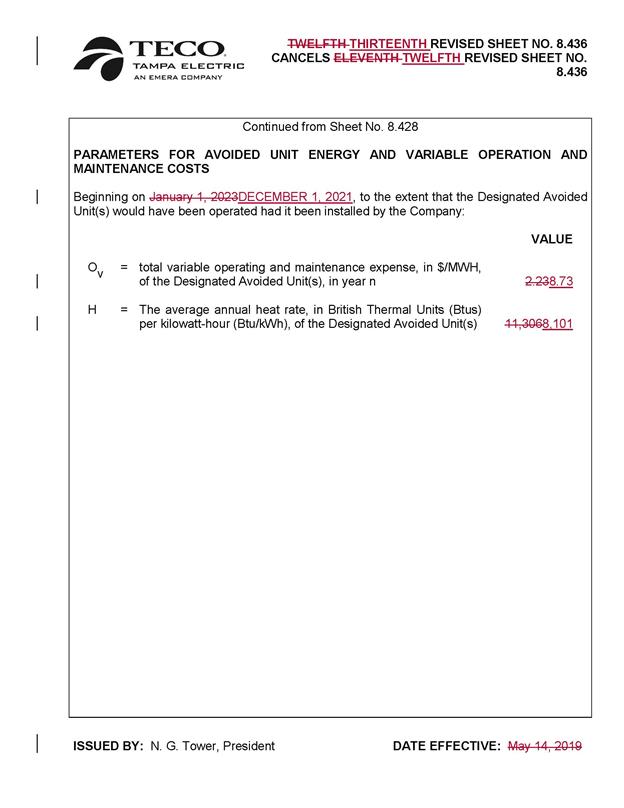

The projected in-service date of the avoided unit is December 1, 2021. This unit is one of five 18.5 MW ICs scheduled to enter service in December 2021, with construction commencing in December 2020. Pursuant to Rule 25-17.250, F.A.C., when this unit is no longer available to be used for the standard offer contract, such as when the utility commences construction, TECO must file a revised standard offer contract based on the next unit of the same generating type, if any. Based on TECO’s 2020 Ten-Year Site Plan, the next avoidable unit would be an IC with an in-service date of January 2025.

Under TECO’s standard offer contract, the RF/QF operator commits to certain minimum performance requirements based on the identified avoided unit, such as being operational and delivering an agreed upon amount of capacity by the in-service date of the avoided unit, and thereby becomes eligible for capacity payments in addition to payments received for energy. The standard offer contract may also serve as a starting point for negotiation of contract terms by providing payment information to an RF/QF operator, in a situation where one or both parties desire particular contract terms other than those established in the standard offer.

In order to promote renewable generation, the Commission requires the IOU to offer multiple options for capacity payments, including the options to receive early or levelized payments. If the RF/QF operator elects to receive capacity payments under the normal or levelized contract options, it will receive as-available energy payments only until the in-service date of the avoided unit (in this case December 1, 2021), and thereafter, begin receiving capacity payments in addition to the energy payments. If either the early or early levelized option is selected, then the operator will begin receiving capacity payments earlier than the in-service date of the avoided unit. However, payments made under the early capacity payment options tend to be lower in the later years of the contract term because the net present value (NPV) of the total payments must remain equal for all contract payment options.

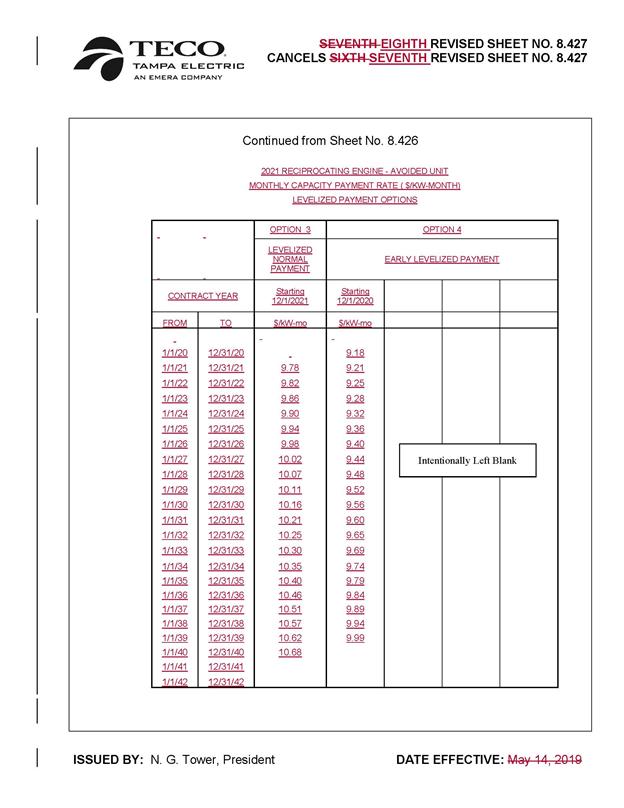

Table 1 contains TECO’s estimates of the annual payments for the normal and levelized capacity payment options available under the revised standard offer contract to an operator with a 50 MW facility, operating at a capacity factor of 80 percent, which is the minimum capacity factor required under the contract to qualify for full capacity payments. Due to the upcoming 2021 in-service date of the avoided unit, no annual examples of early payments are provided. Early payments, if applicable, would be made for months avoided. Normal and levelized capacity payments begin with the projected in-service date of the avoided unit (December 1, 2021).

Table 1 - Estimated Annual Payments to a 50 MW Renewable Facility

(80% Capacity Factor)

Year

Energy Payments

Capacity Payments

Normal

Levelized

$(000)

$(000)

$(000)

2021[1]

9,516

5,403

5,867

2022

9,983

5,513

5,890

2023

9,437

5,626

5,914

2024

10,123

5,740

5,938

2025

10,786

5,857

5,963

2026

12,338

5,977

5,988

2027

12,361

6,099

6,014

2028

12,992

6,223

6,041

2029

13,728

6,350

6,068

2030

15,129

6,479

6,095

2031

15,771

6,612

6,124

2032

16,415

6,746

6,152

2033

16,836

6,884

6,182

2034

18,363

7,024

6,212

2035

19,149

7,168

6,243

2036

20,040

7,314

6,274

2037

21,631

7,463

6,307

2038

22,260

7,615

6,339

2039

23,129

7,771

6,373

2040

24,434

7,929

6,407

Total (Nominal)

323,810

131,794

122,393

Total (NPV)

179,896

65,718

65,718

      Source: TECO’s Response to Staff’s First Data Request[2]

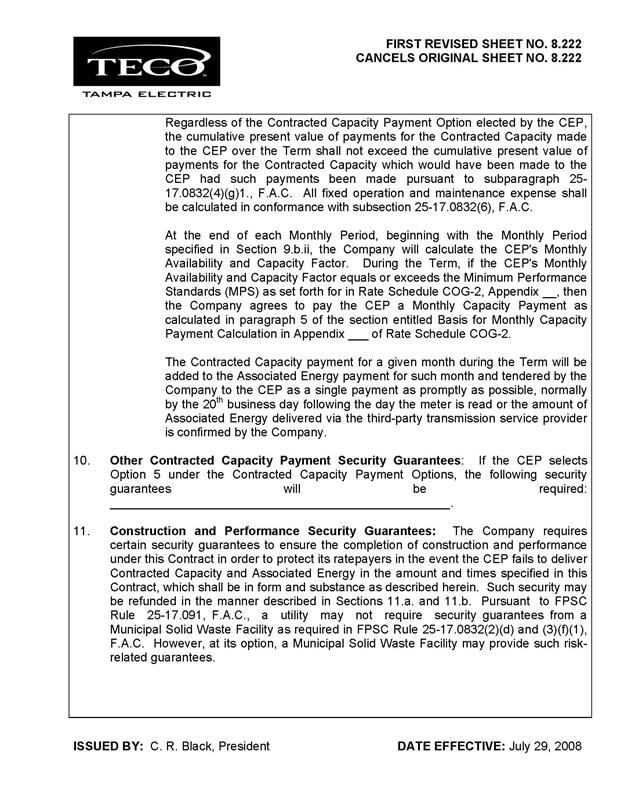

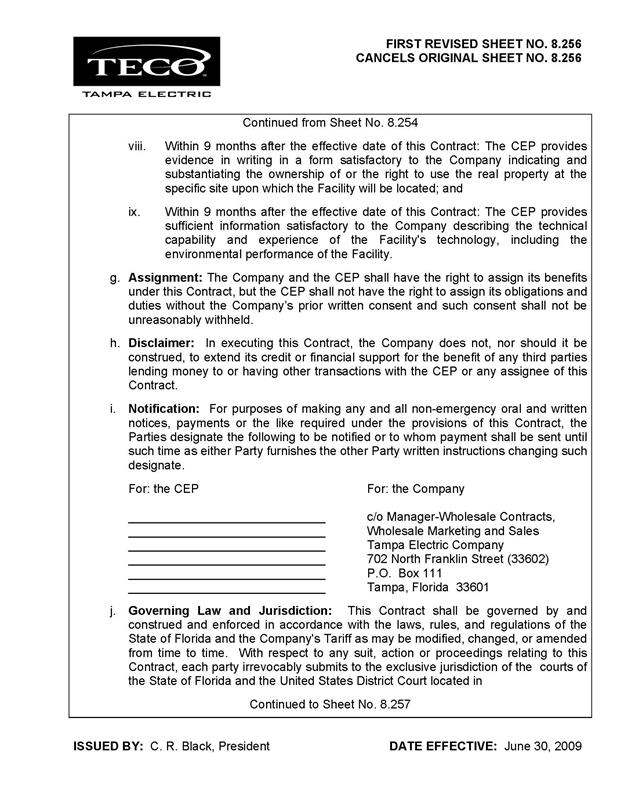

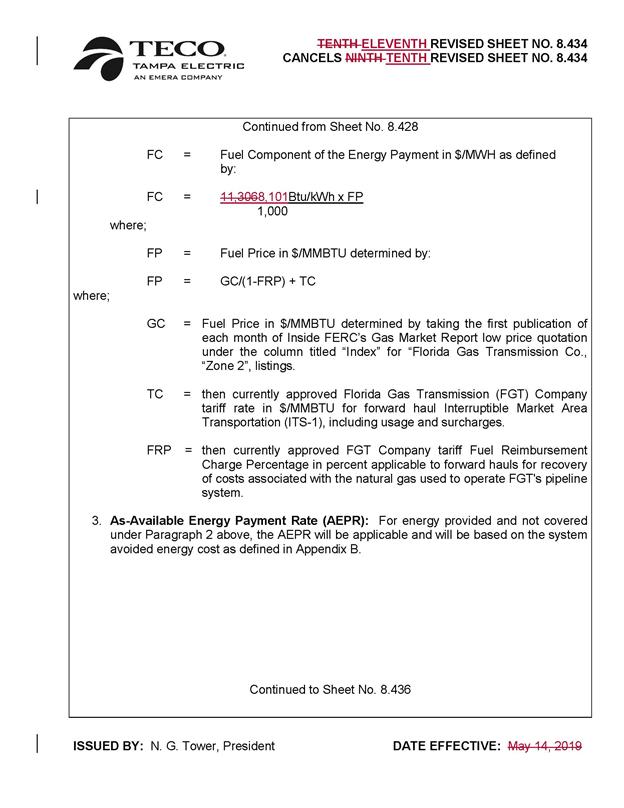

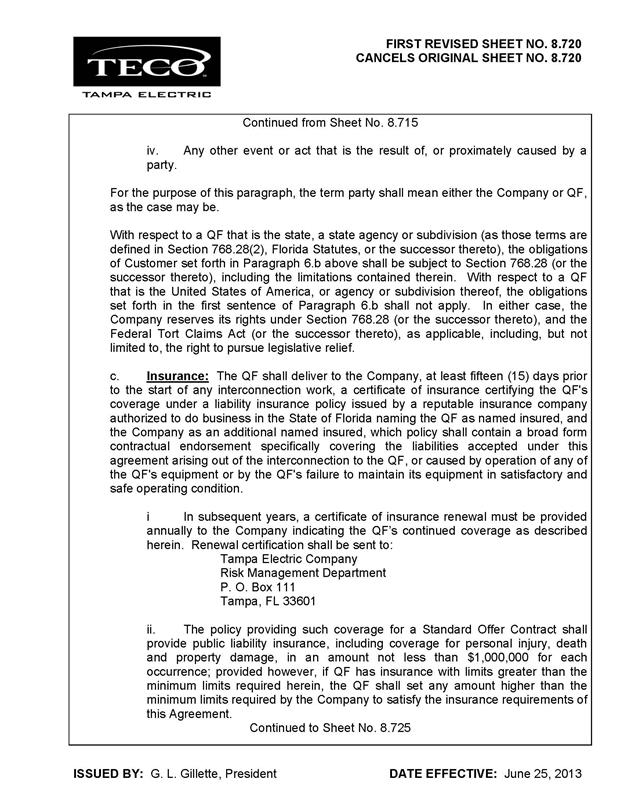

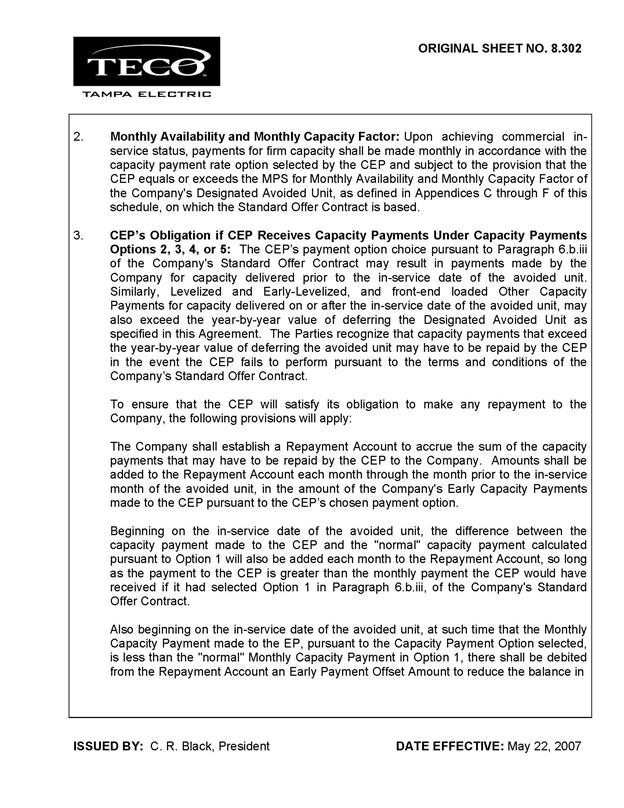

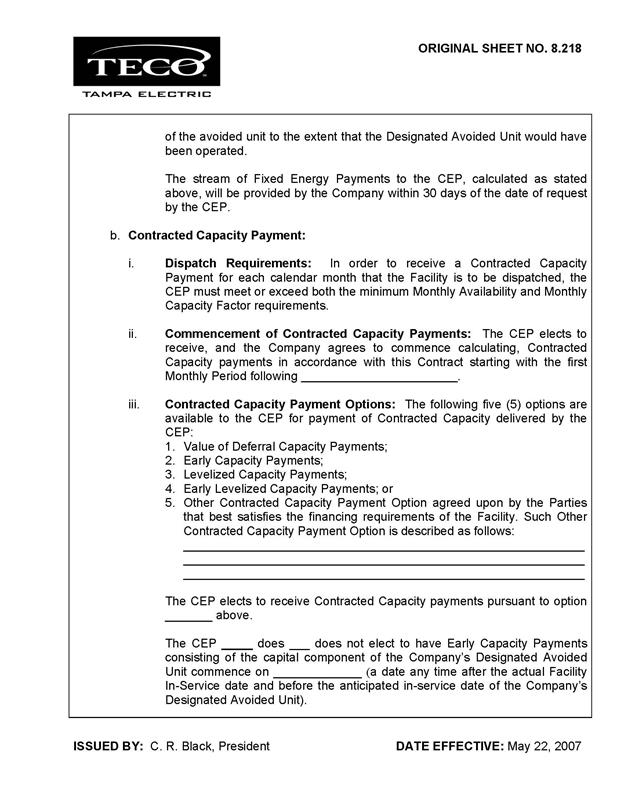

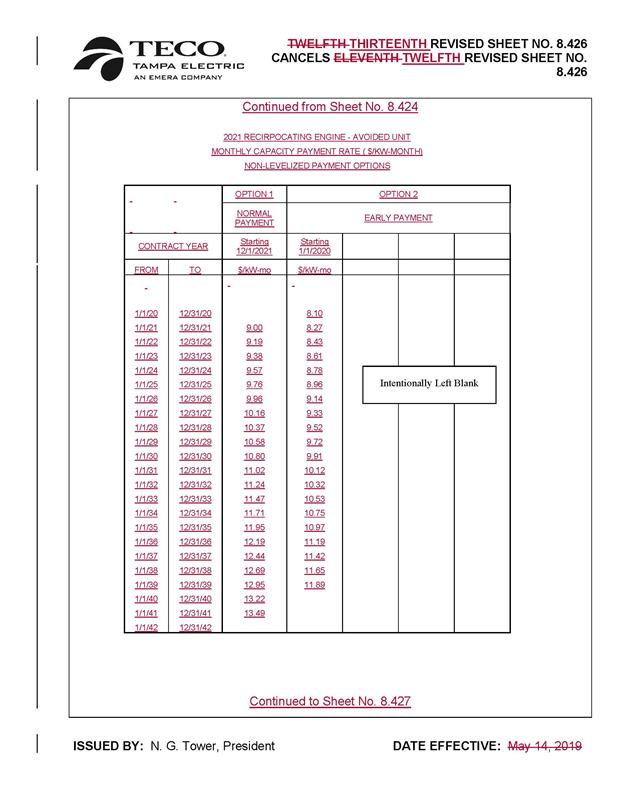

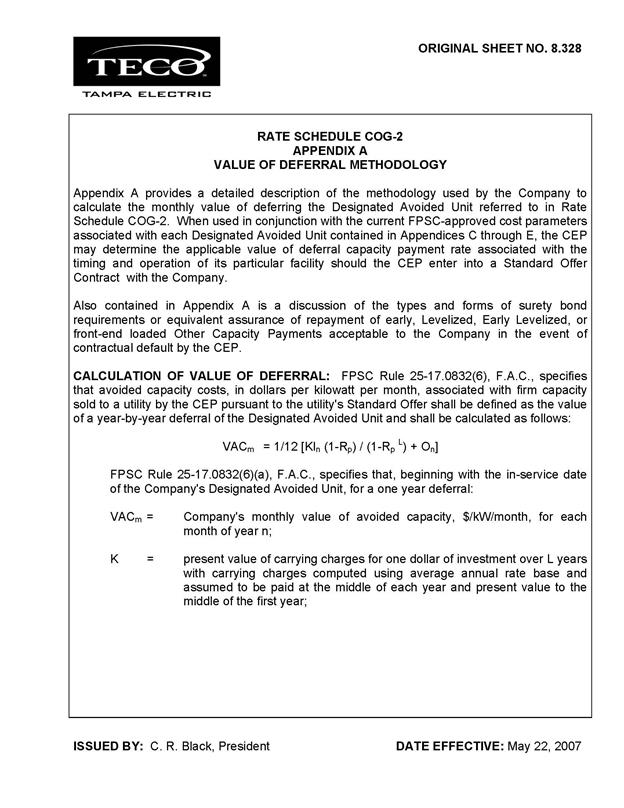

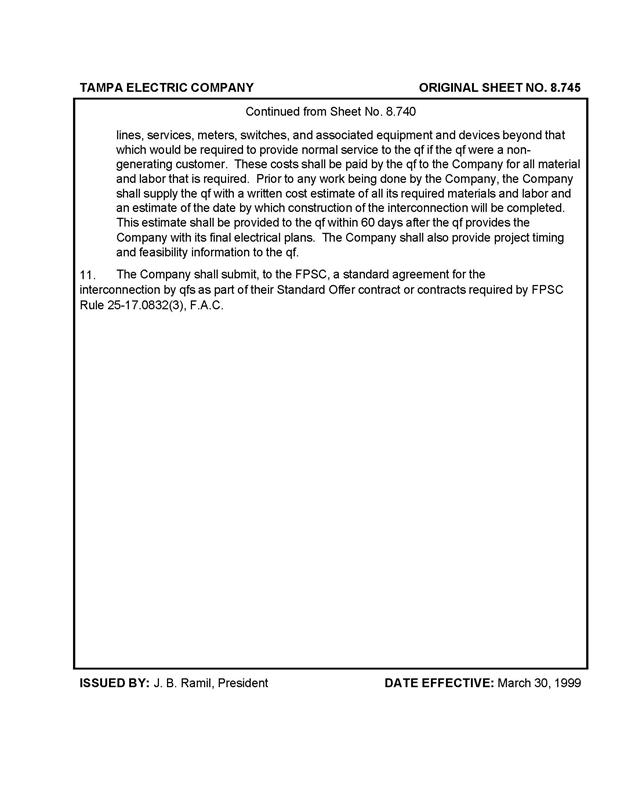

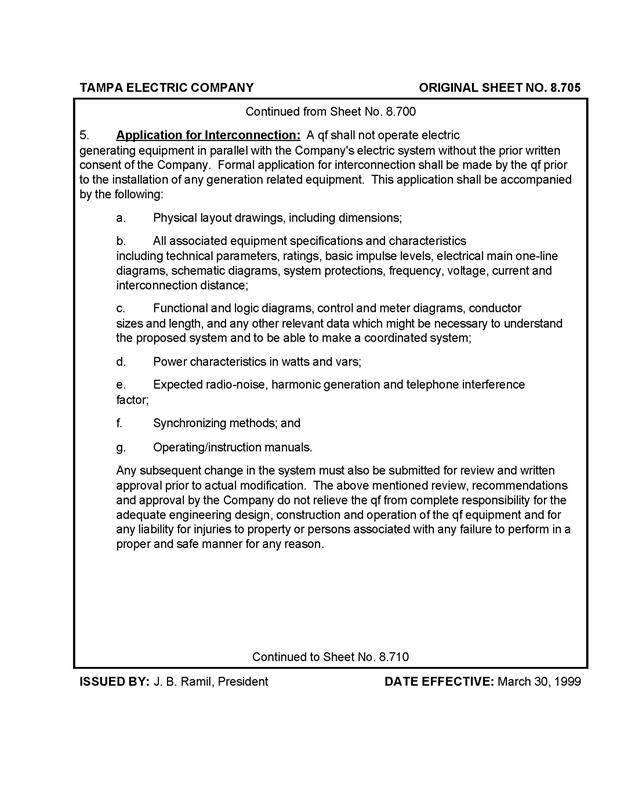

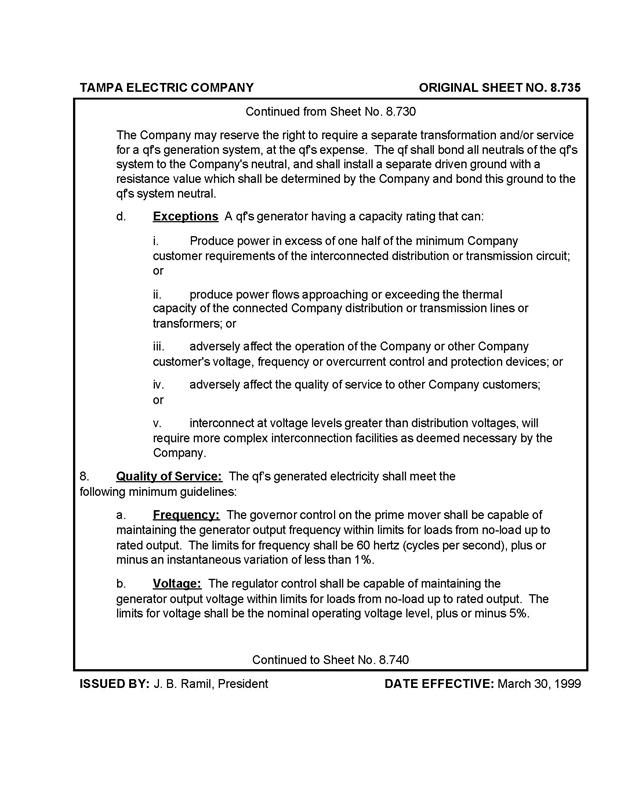

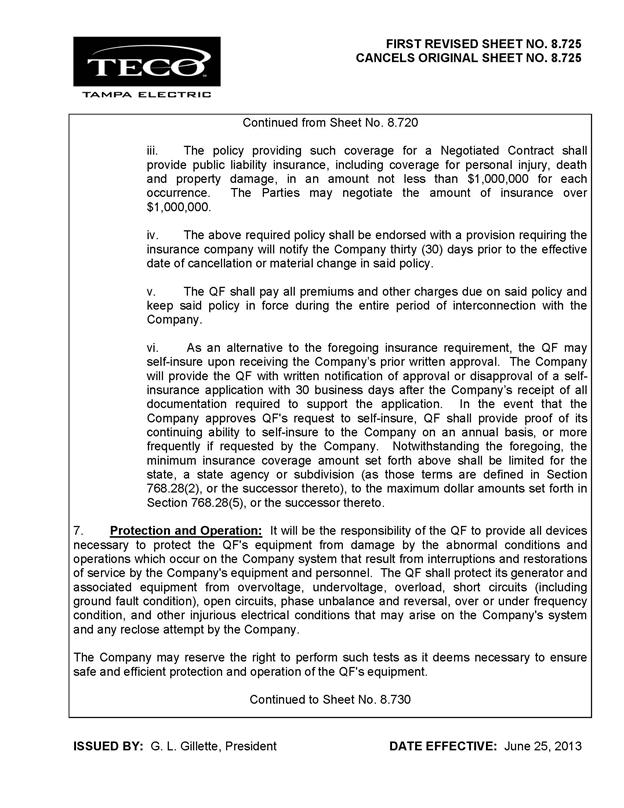

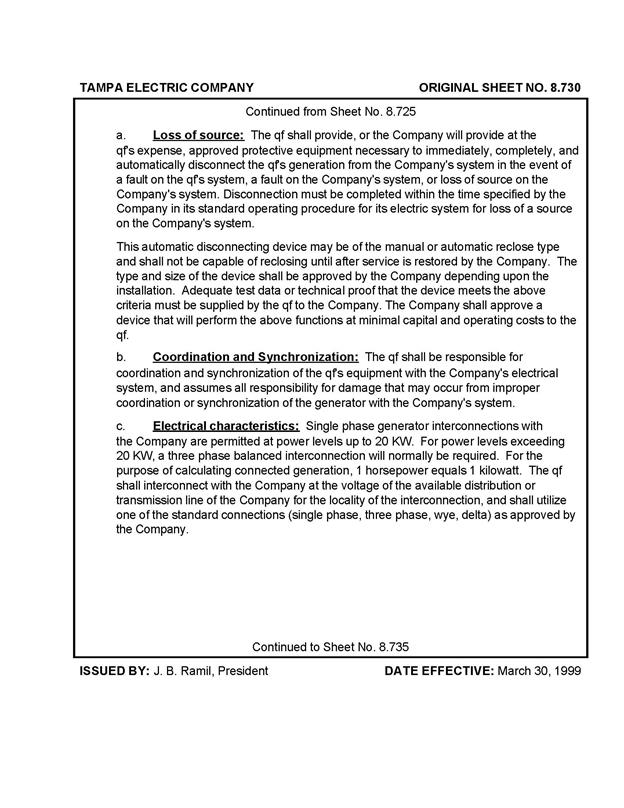

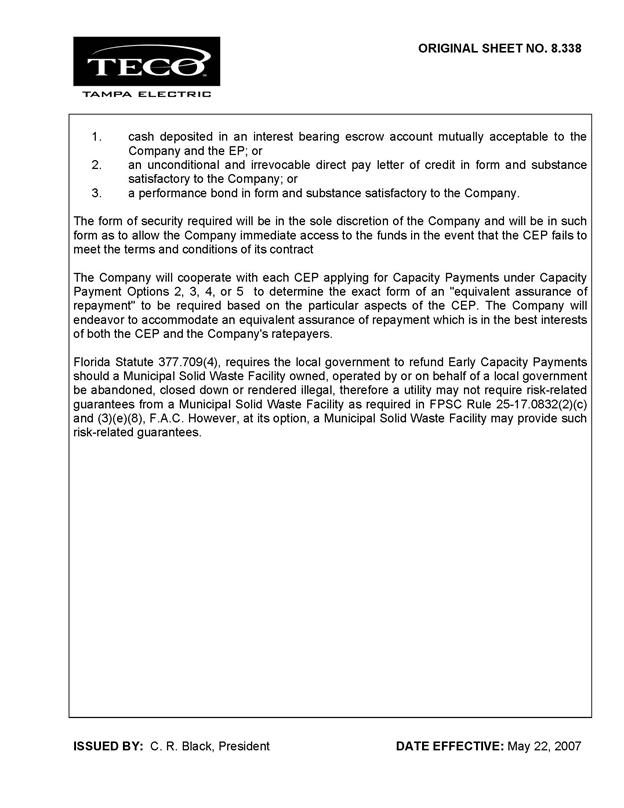

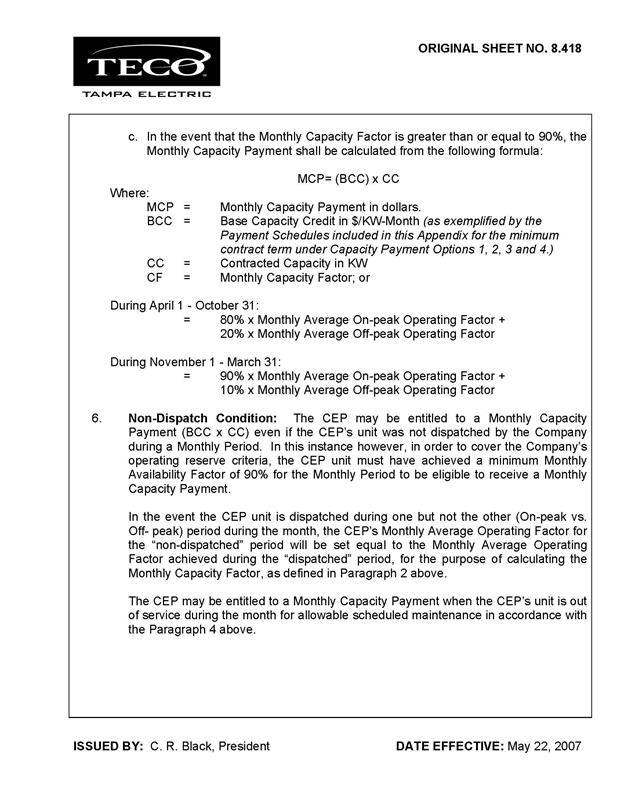

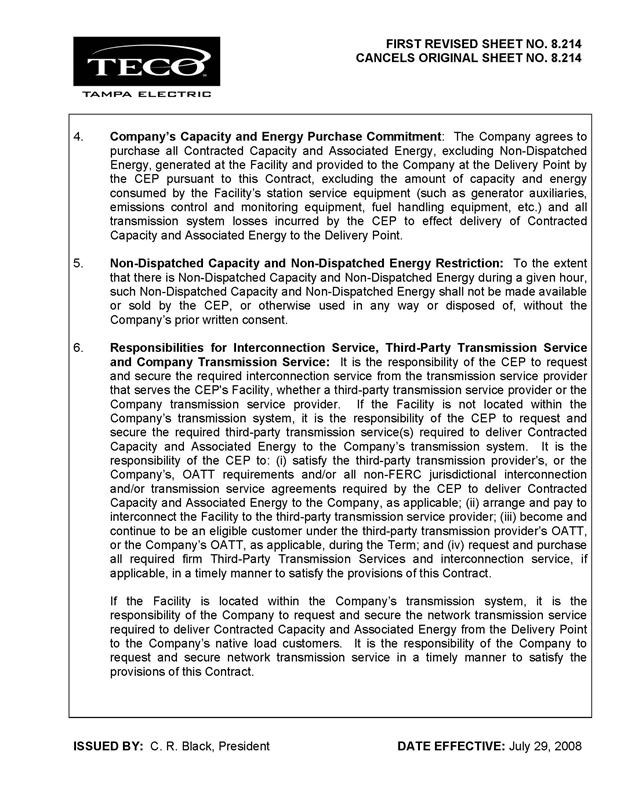

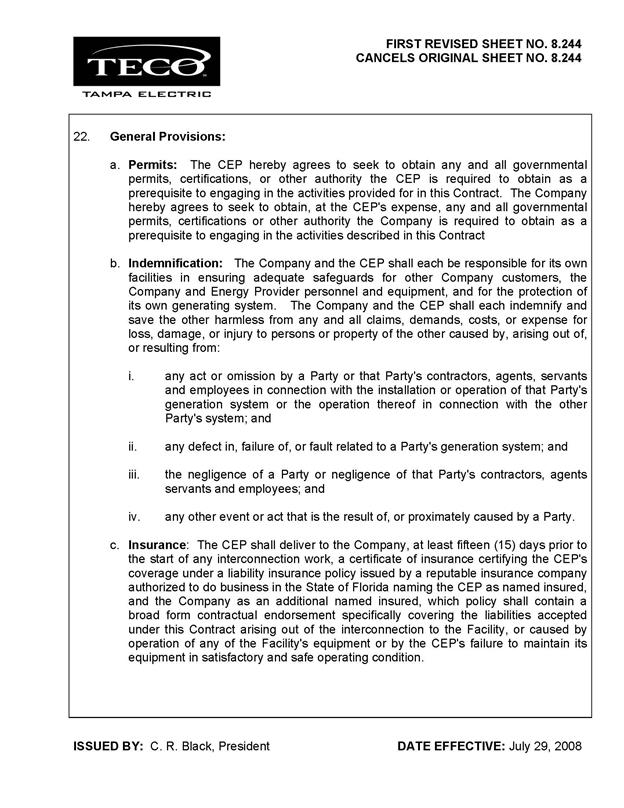

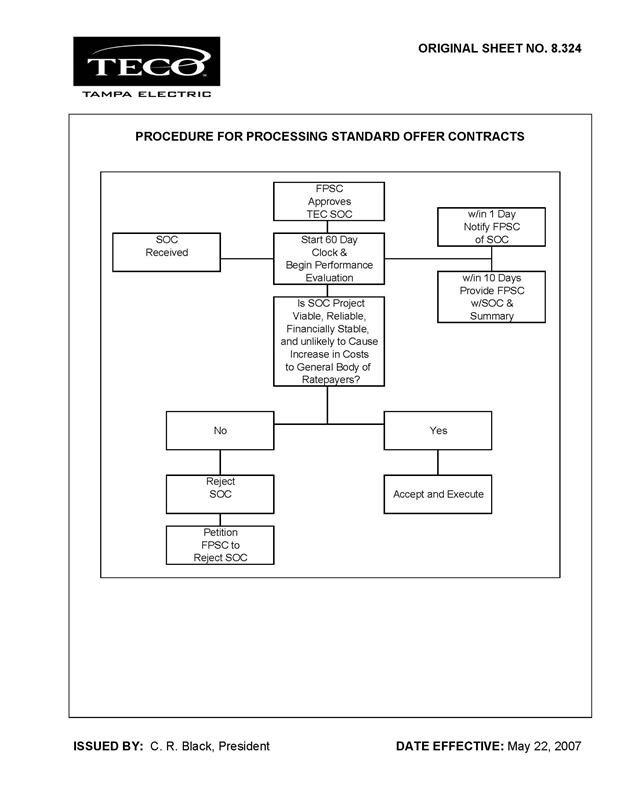

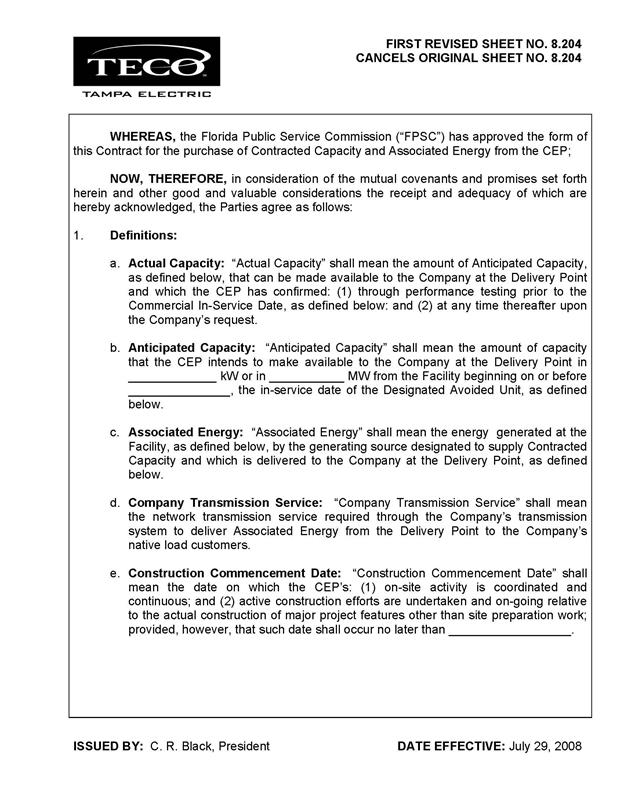

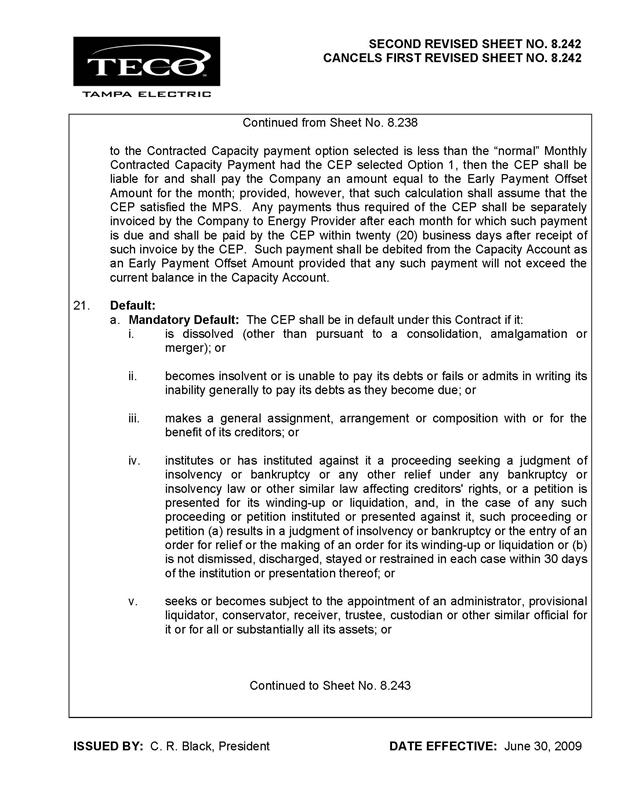

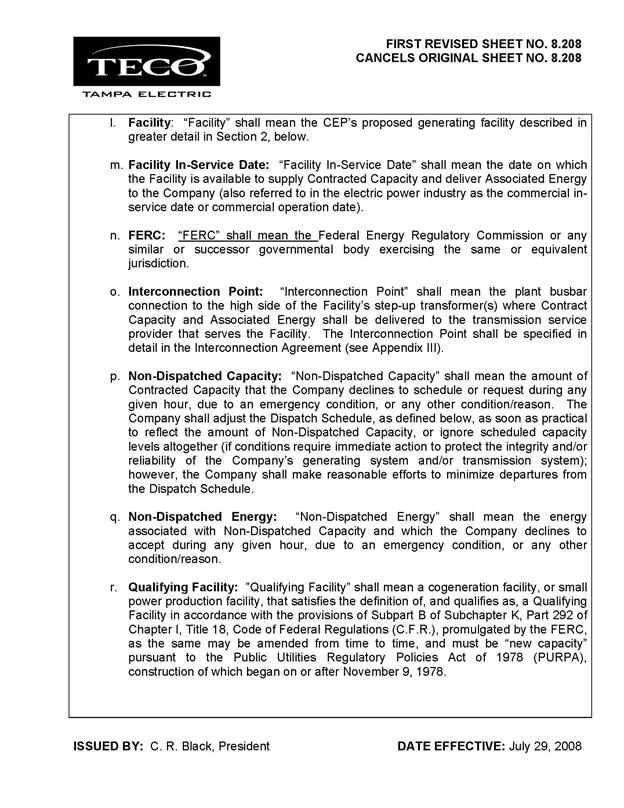

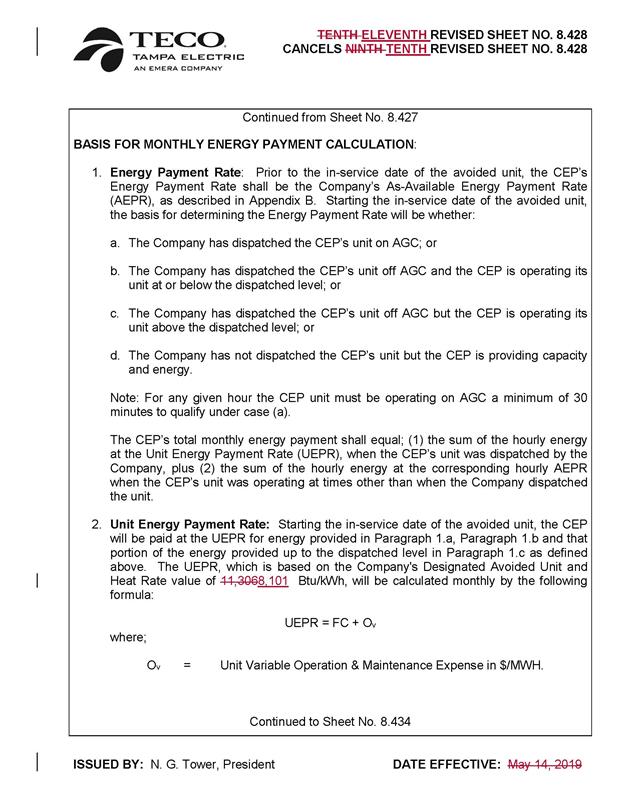

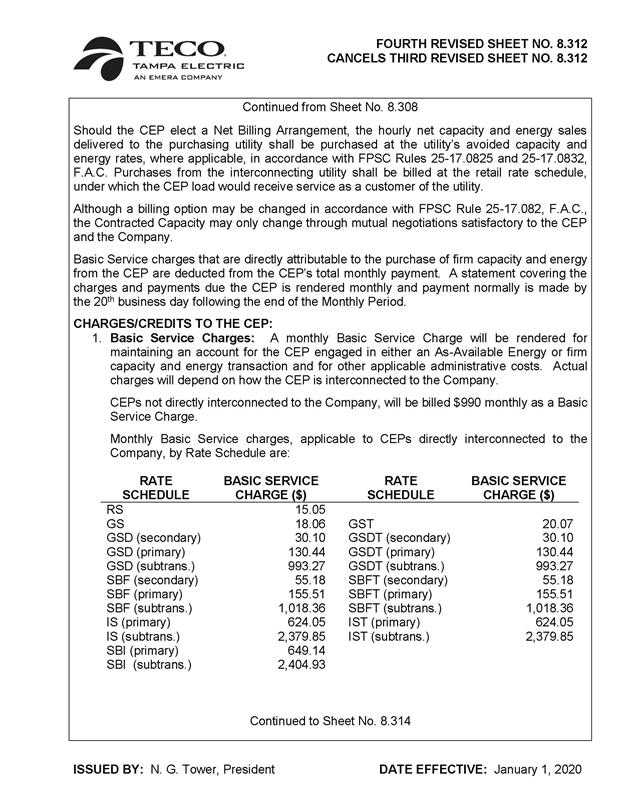

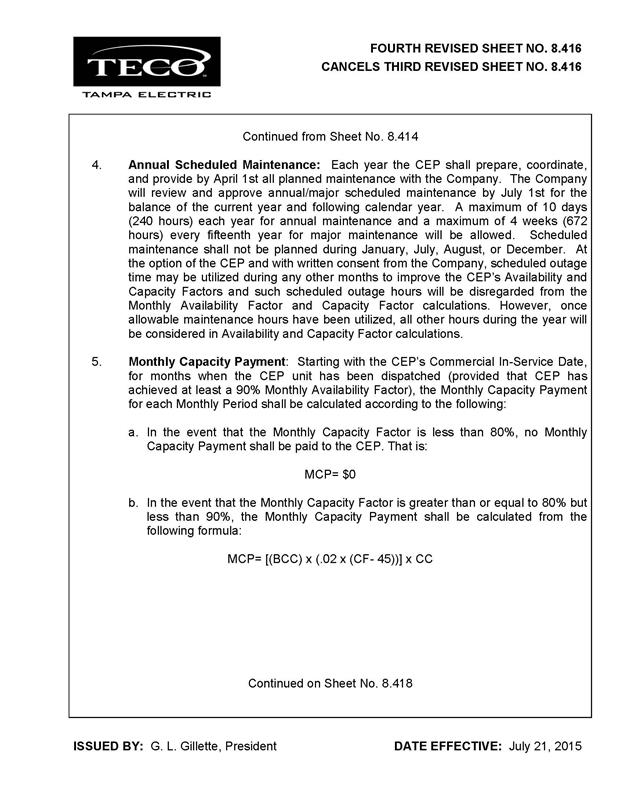

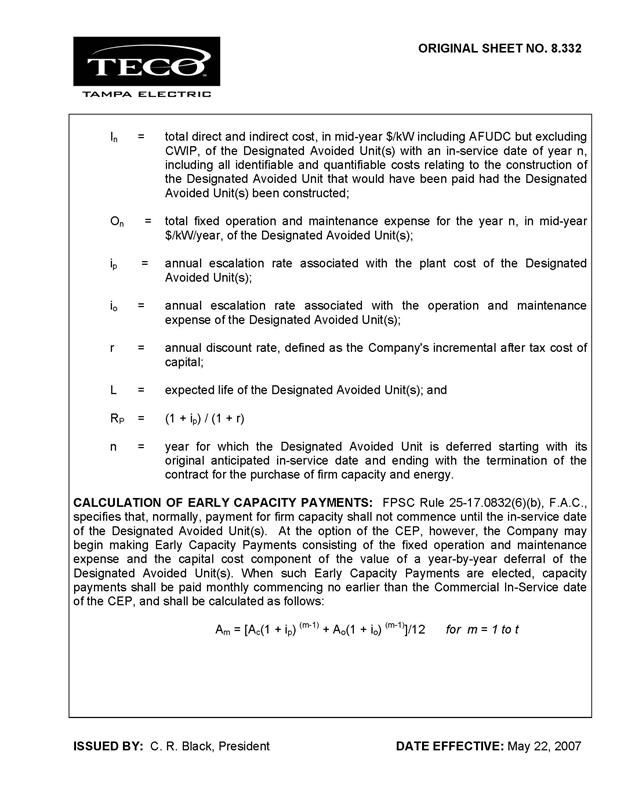

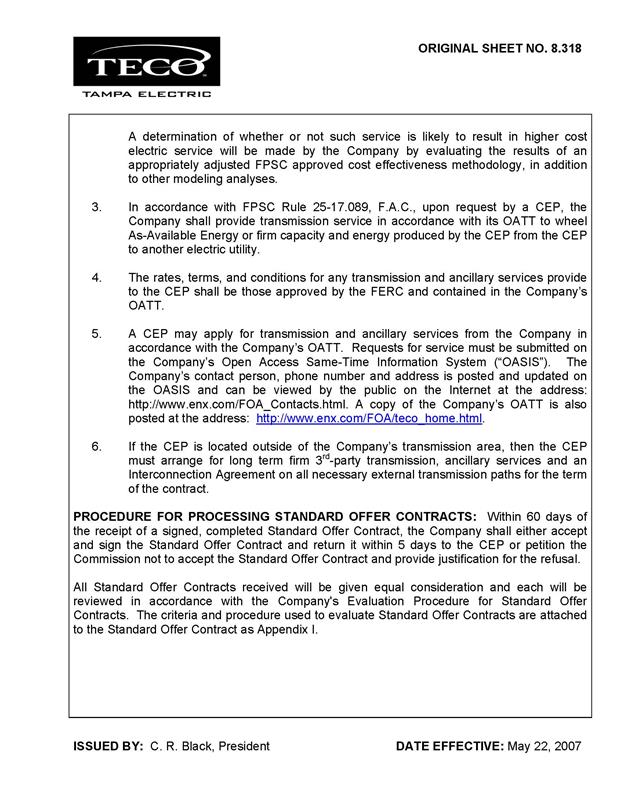

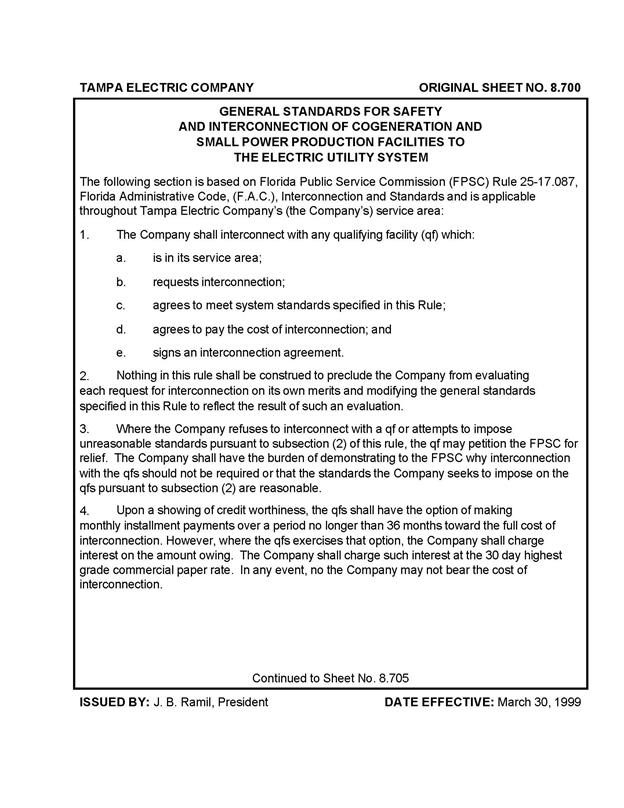

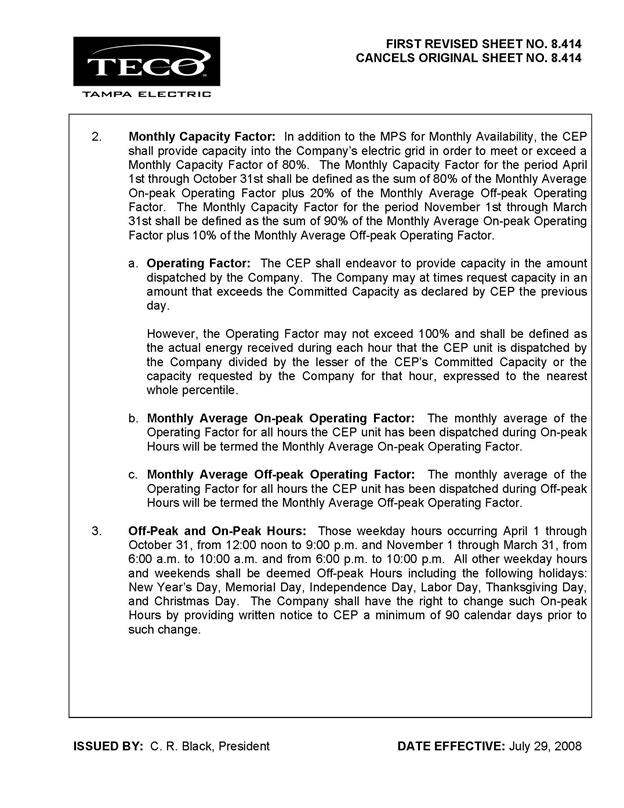

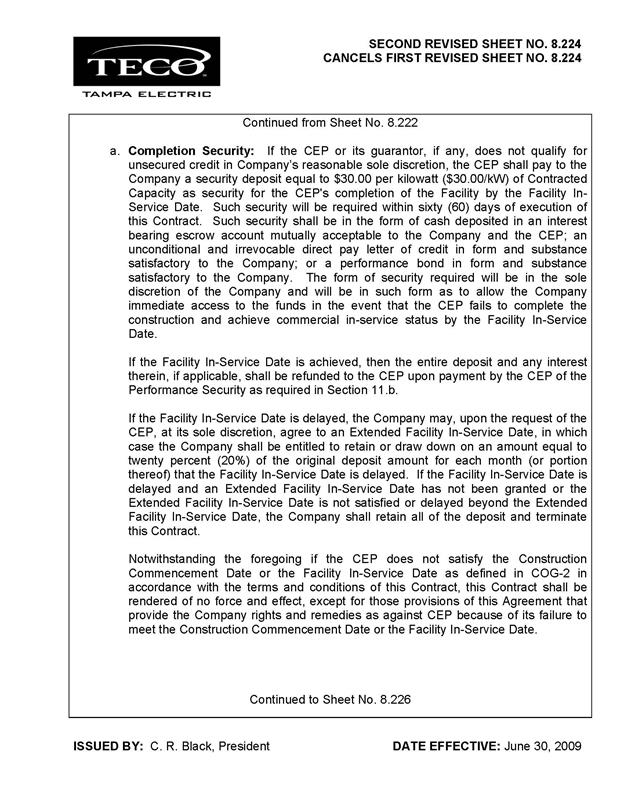

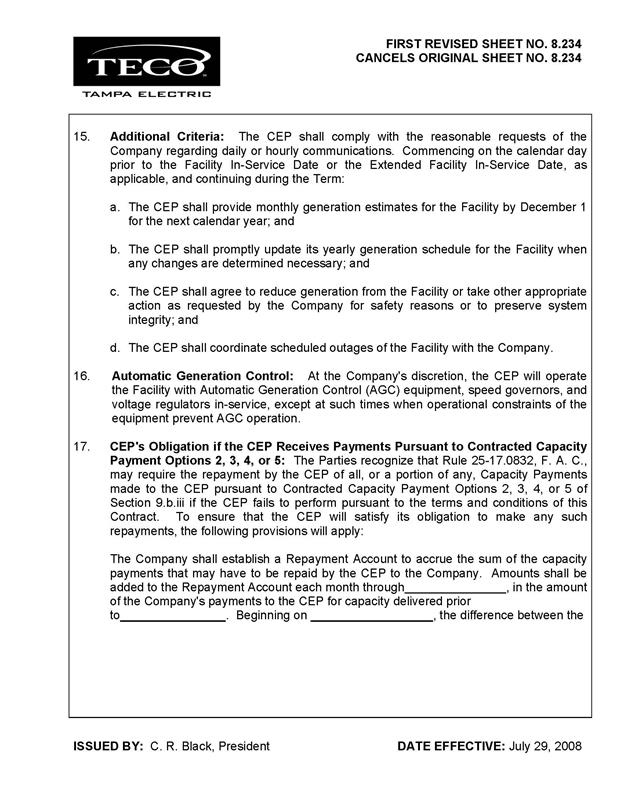

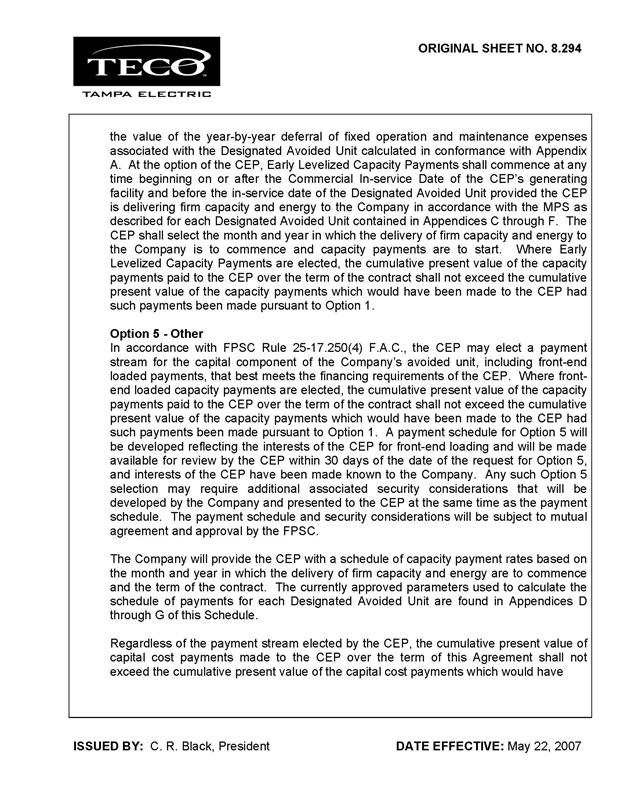

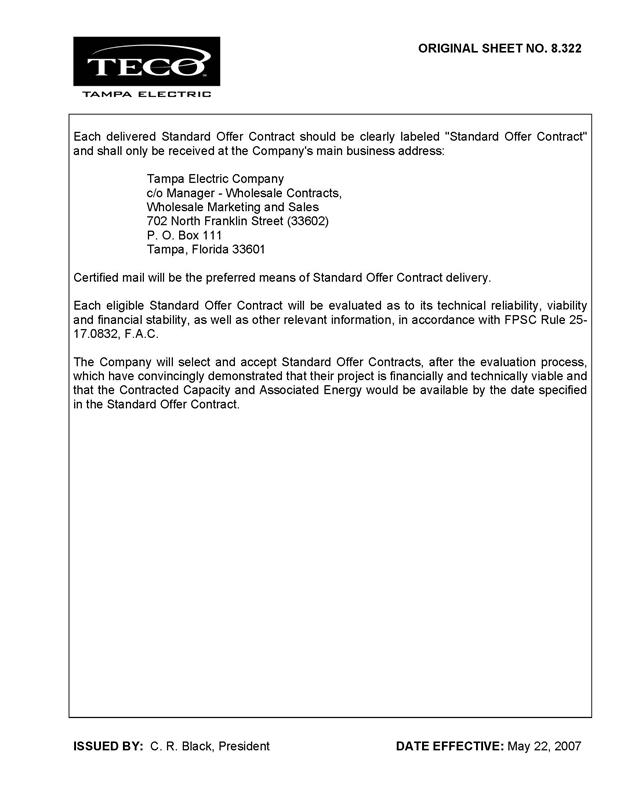

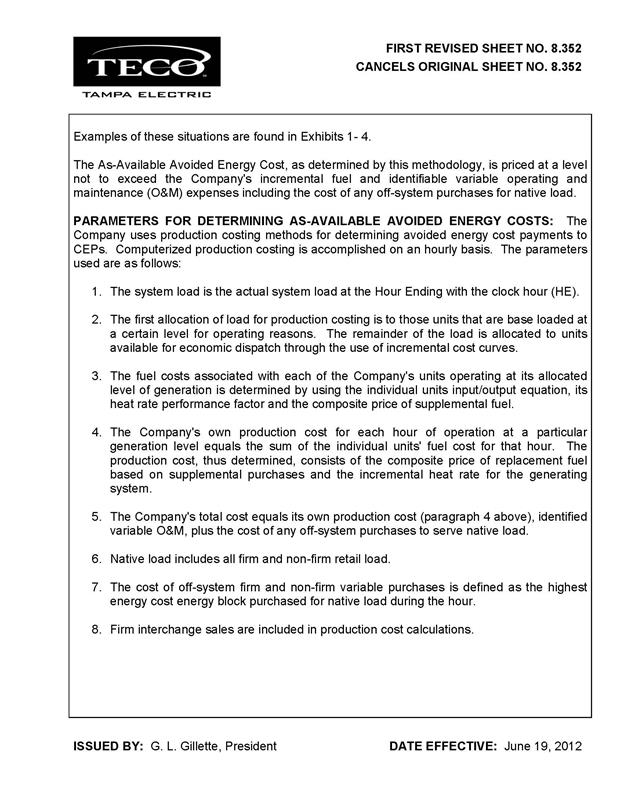

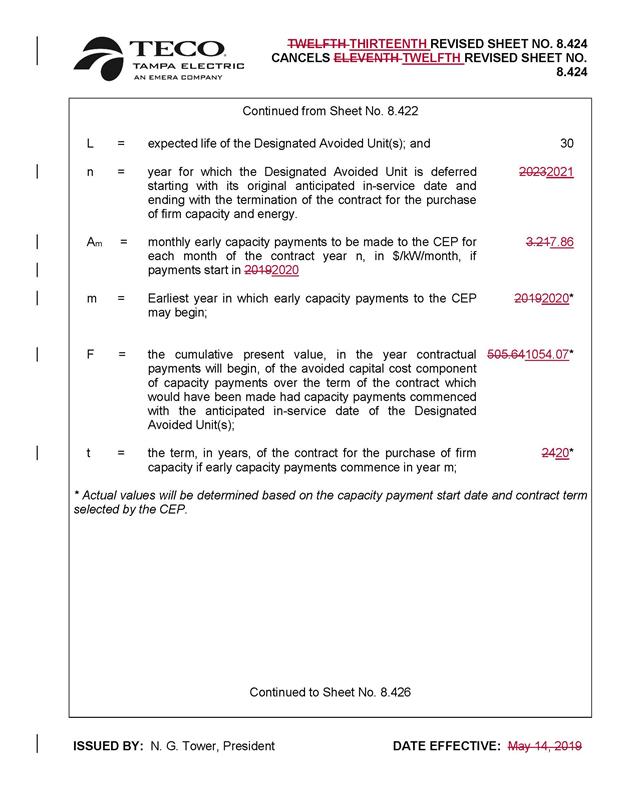

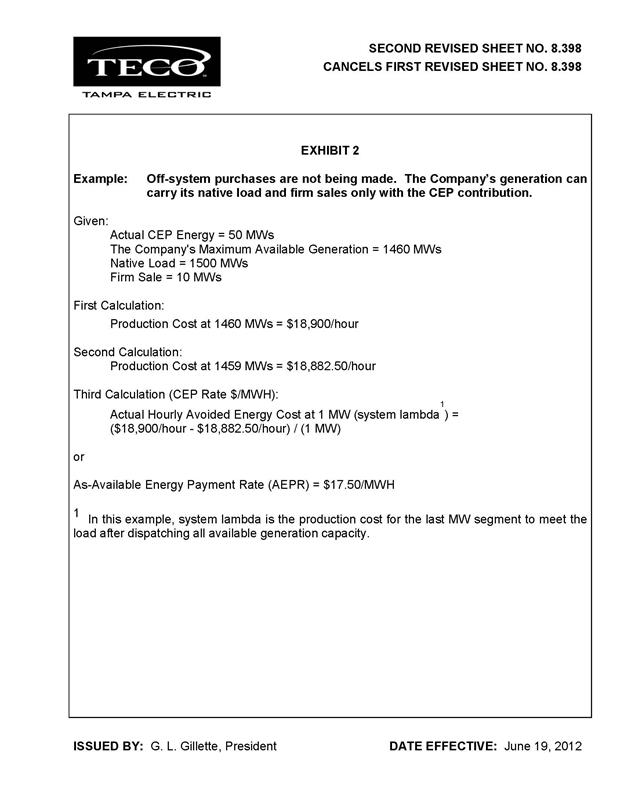

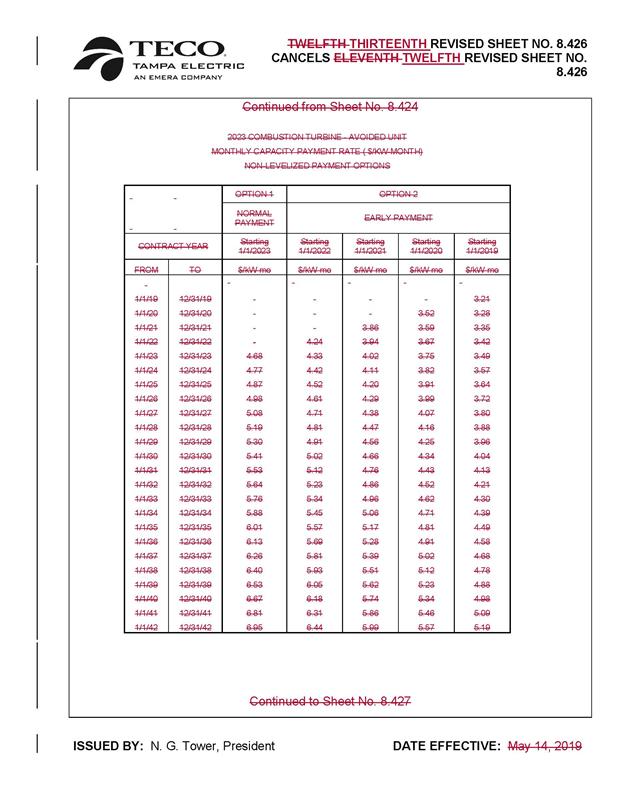

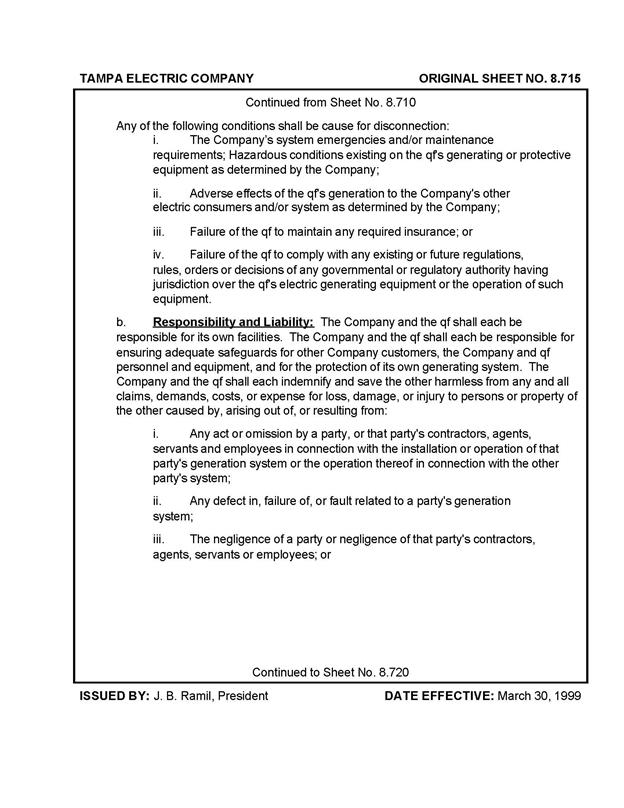

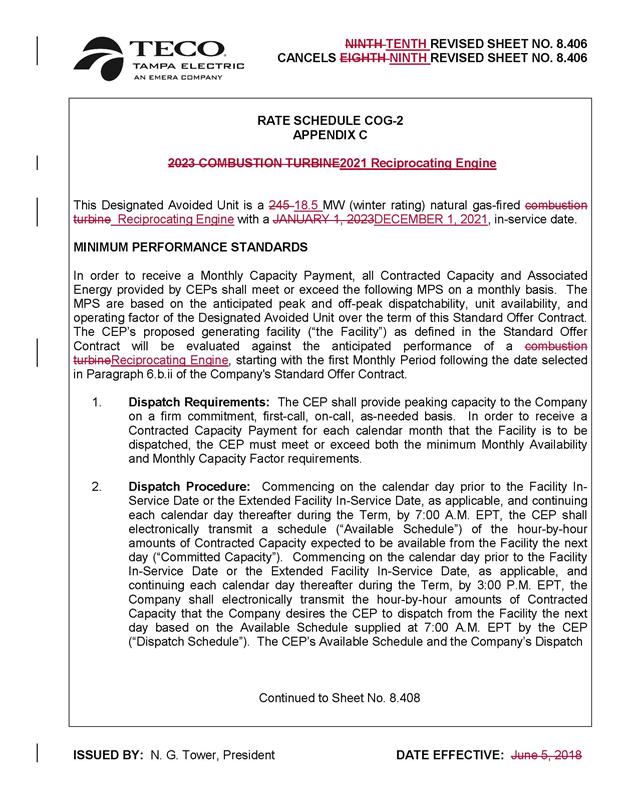

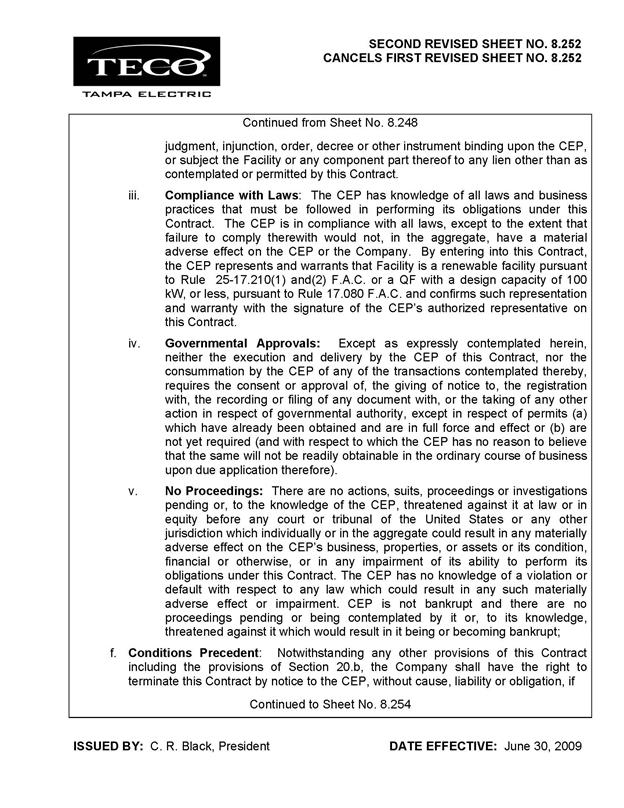

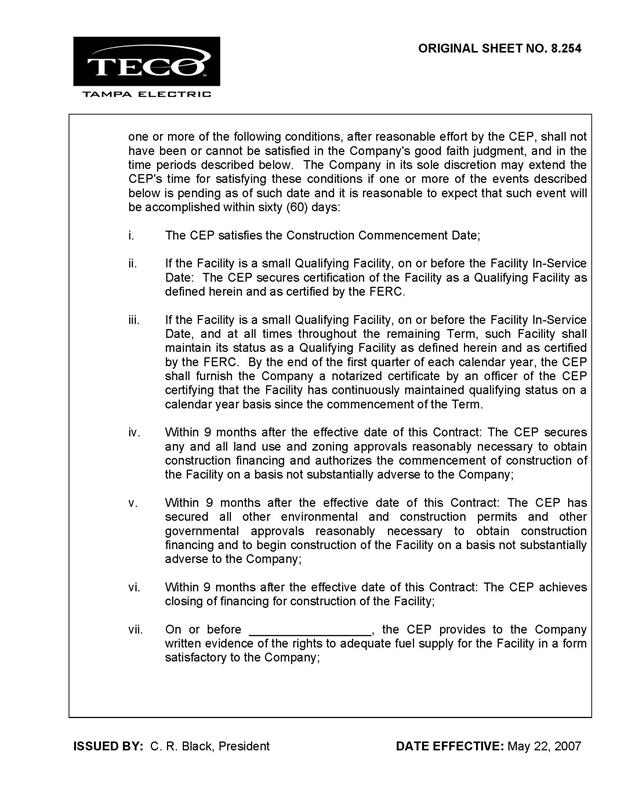

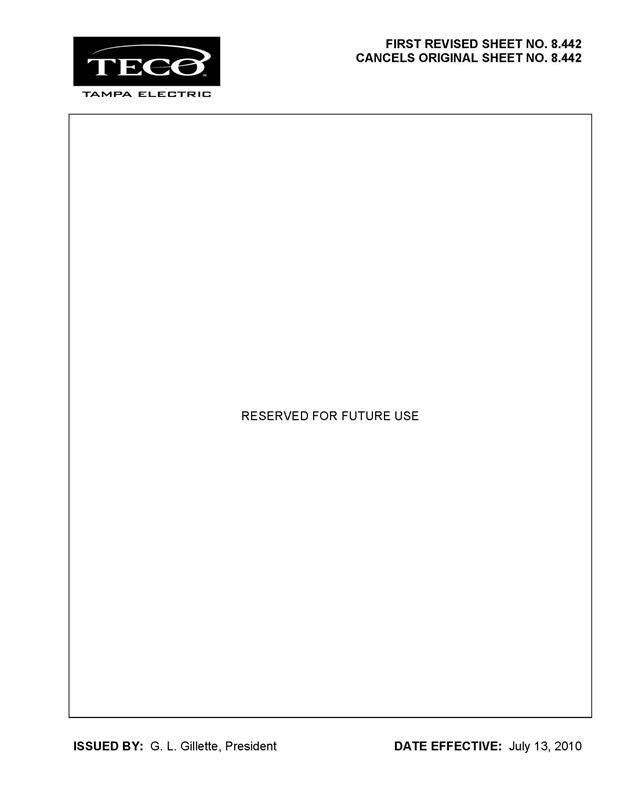

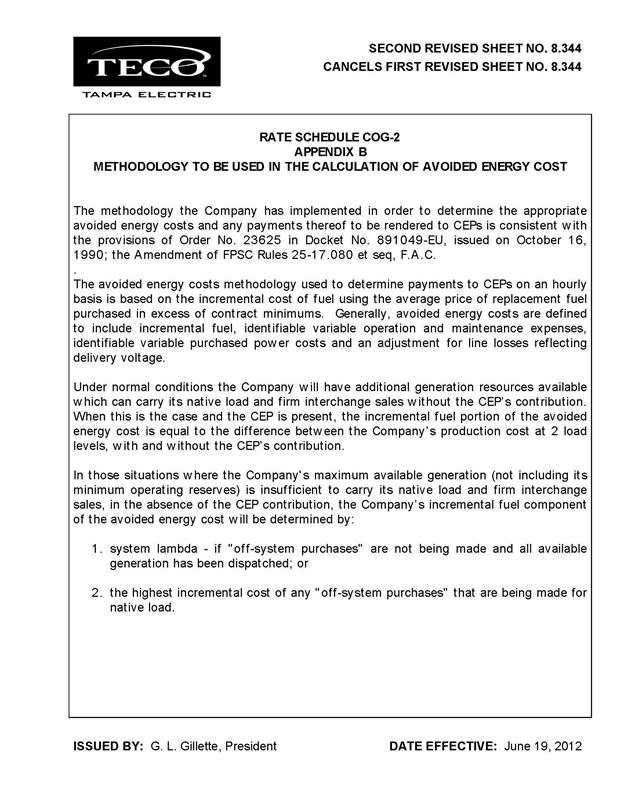

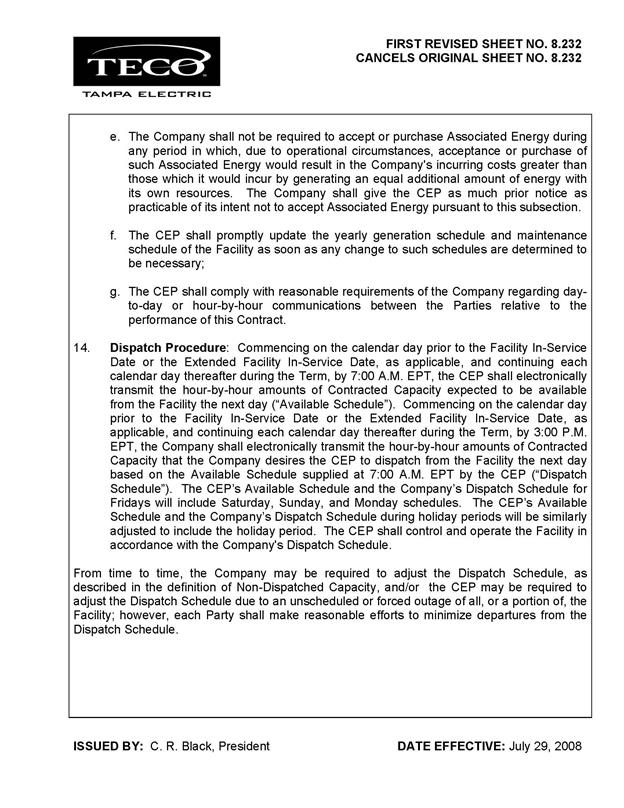

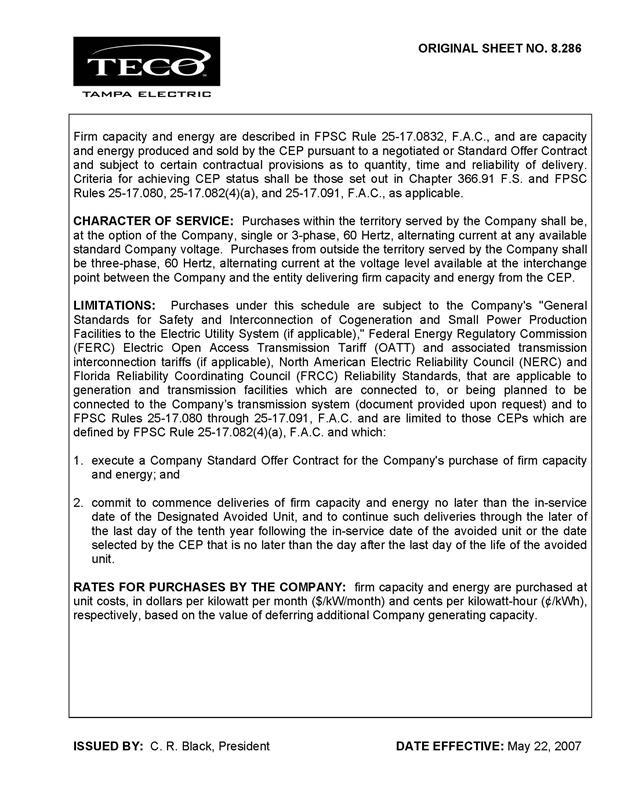

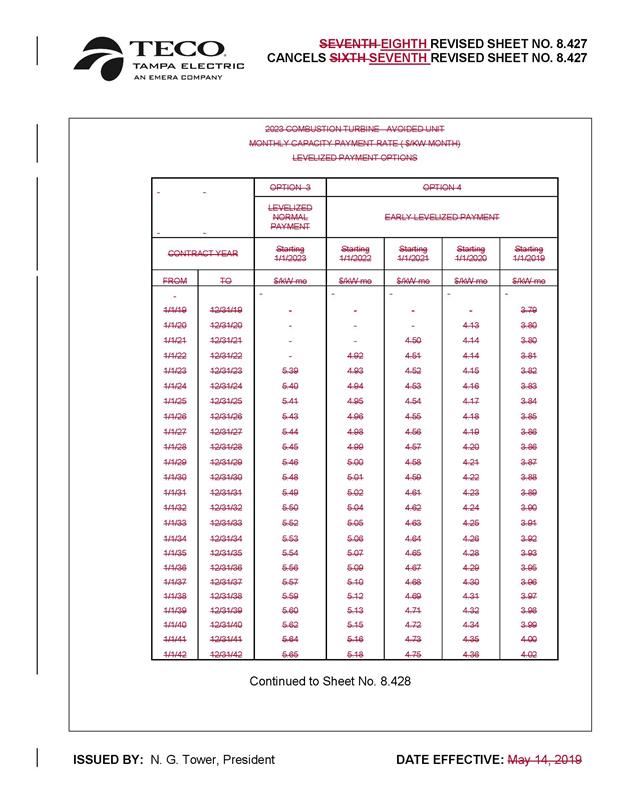

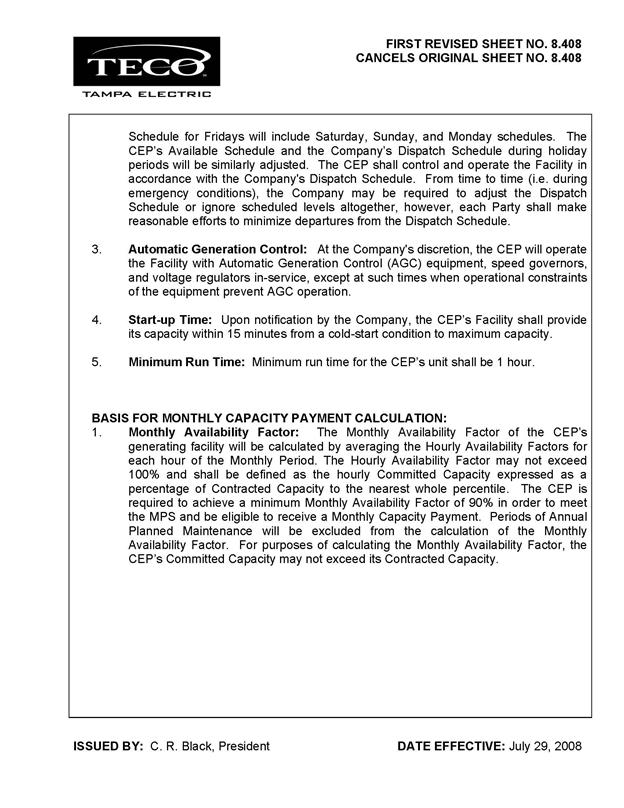

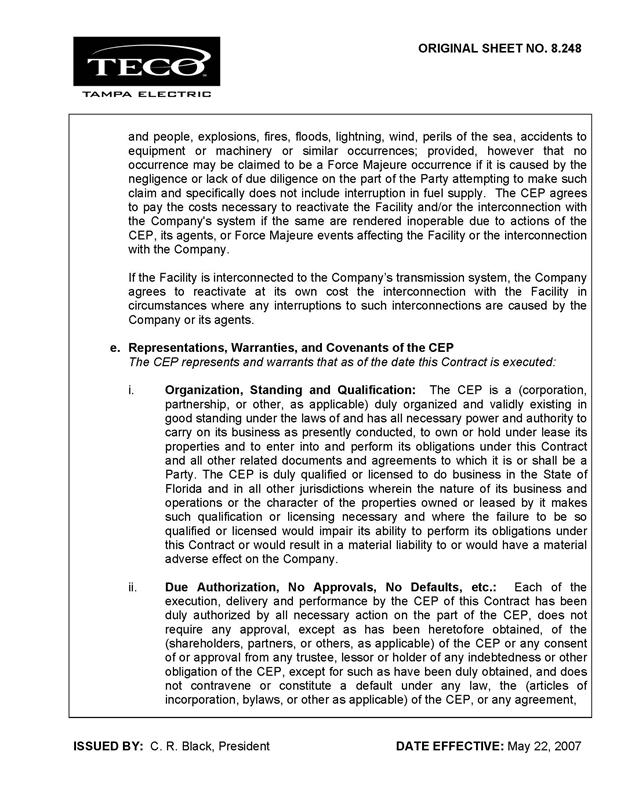

TECO’s standard offer contract, in type-and-strike format, is included as Attachment A to this recommendation. The changes made to TECO’s tariff sheets are consistent with the updated avoided unit. Revisions include updates to calendar dates and payment information which reflect the current economic and financial assumptions for the avoided unit.

Conclusion

Staff recommends that the amended standard offer contract and rate schedule COG-2 be approved as filed. The provisions of TECO’s amended standard offer contract and associated rate schedule conform to all requirements of Rules 25-17.200 through 25-17.310, F.A.C. The amended standard offer contract provides flexibility in the arrangements for payments so that a developer of renewable generation may select the payment stream best suited to its financial needs.
Issue 2:

 Should this docket be closed?

Recommendation:

 Yes. This docket should be closed upon issuance of a consummating order, unless a person whose substantial interests are affected by the Commission’s decision files a protest within 21 days of the issuance of the Commission’s Proposed Agency Action Order. Potential signatories should be aware that, if a timely protest is filed, TECO’s standard offer contract may subsequently be revised. (Passidomo)

Staff Analysis:

 This docket should be closed upon the issuance of a consummating order, unless a person whose substantial interests are affected by the Commission’s decision files a protest within 21 days of the issuance of the Commission’s Proposed Agency Action Order. Potential signatories should be aware that, if a timely protest is filed, TECO’s standard offer contract may subsequently be revised.

[1]While Row values for 2021 are the annual value, an RF/QF would only be eligible for a single month.

[2]Document No. 02003-2020, filed April 17, 2020, in Docket No. 20200111-EQ.
